$33 Billion and Counting (Part II)

In the first article in this series, I reviewed the Capital Budget and Plan that covers the years 2019-2033 for the TTC. There are three reports on the January 24 Board agenda related to this subject:

This article concentrates on the “Making Headway” report which is a glossy overview of the 15 Year Capital Plan. It is a generally good report, although there are annoying omissions of detail that would flesh out its argument.

This report deals mainly with “state of good repair” (SOGR) projects that involve rejuvenation of existing infrastructure and expansion necessary to handle growing demand. New lines are not, for the most part, included in the report although plans for them are reflected in SOGR planning where they trigger expansion of existing capacity. Leaving out new projects like the Richmond Hill extension may be a political decision, but this means that the context for some recommendations is incomplete. A useful update would be to produce a consolidated plan showing the “new” projects and the time-critical events they trigger (such as fleet expansion or replacement and station capacity issues).

For many years, the TTC, the City of Toronto and its so-called funding partners have been content for the official SOGR backlog to stay out of sight. This has the triple benefit of reducing the projected borrowing TTC projects will require, making the benefit of capital funding the TTC does receive (mainly from gas tax) appear larger than what is needed, and avoiding difficult questions about spending on new projects in the face of a gaping hole for existing maintenance. This must stop, and the “Making Headway” report certainly puts the TTC’s needs in a different, and far more critical, light.

A backlog of deferred maintenance has grown, putting the safety, accessibility and sustainability of our transit system at risk despite the need to move more customers more reliably than ever before. [p. 7]

One cannot help remembering the soothing words of TTC management in the early 1990s when recession-starved governments cut back on transit maintenance, and the TTC said they could get by on the money they received without compromising the system. Then there was the fatal crash at Russell Hill and, bit by bit, Toronto learned just how badly the TTC’s condition had fallen. The CEO at the time (a position then called “Chief General Manager”) went on to become a Minister in the Harris government that slashed provincial transit funding completely. Things appear to be different today with the TTC calling out for better funding, although at a time when the last thing any politician wants to hear is a plea for more spending.

One page should be burned into the souls of anyone who claims to support transit’s vital role:

It is easy for the need to invest in our base transit system to be overshadowed by the need to fund transit expansion. But investing to properly maintain and increase the capacity of our current system is arguably even more important.

Population growth and planned transit expansion projects such as SmartTrack, the Relief Line South, the Line 2 East Extension to Scarborough and new LRT lines on Eglinton and Finch West will add hundreds of thousands more customers to Toronto’s transit network.

The result will dramatically increase pressure on a system already grappling with an aging fleet, outdated signals on key subway lines, inadequate maintenance and storage capacity, and tracks and infrastructure in need of constant repair.

Without the investments outlined in this Plan, service reliability and crowding will worsen, as the maintenance backlog grows and becomes more difficult and costlier to fix. This is the fate now faced by some other major transit systems in North America that allowed their assets to badly deteriorate.

Our customers, our city, our province and our nation can’t afford to let that happen. [p. 8]

This is not the message recent and current leaders in Toronto and Ontario wanted to hear, and they collectively are to blame for the mess we are in today.

Although some items, particularly those in the second decade of the plan, are not fully costed, the items are included to raise awareness that they exist.

Given the scale of the investment required, however, it would be irresponsible to delay conversations about funding until estimates are exact. [p. 9]

There is a mythology about transit assets, particularly subways, that they last a century. This is nowhere near the truth, and those who push such claims as a justification for subways as a preferred mode are flat out liars. Only the physical structure lasts many decades, and even that requires ongoing repair. Components such as trains, track, escalators, electrical systems, signals, tunnels, pumps and station buildings require repair and replacement at regular intervals. The Yonge subway, now over 60 years old, is on its third set of trains, and the Bloor-Danforth line on its second. All of the track has been replaced two or three times. Stations do not have their original escalators, and the ones now in place are coming due for major overhaul or replacement. The list is endless. A subway is not a “build it and forget it” project any more than a new car or a new house.

When the existing system is asked to carry far more riders, more is needed than a new coat of paint. More trains and bigger stations are just a start, and the analogy would be trading up to a family SUV or moving to a bigger house. If Toronto were a stagnant city with little population or job growth, this would be less of an issue, but Toronto is instead a booming area facing problems of growth it cannot serve or chooses not to serve adequately.

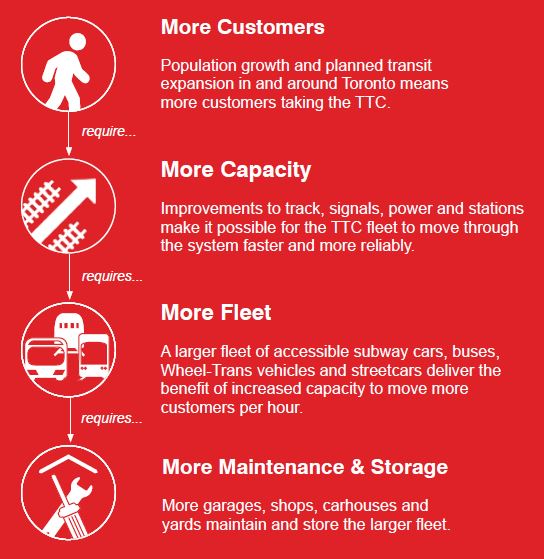

The chart below shows how many aspects of a transit system are linked together. We cannot simply say “buy more buses” or “run more trains” and think that every problem is solved. This problem is compounded when any “improvement” we make vanishes into the black hole of deferred maintenance, making up for what we should have done years ago.

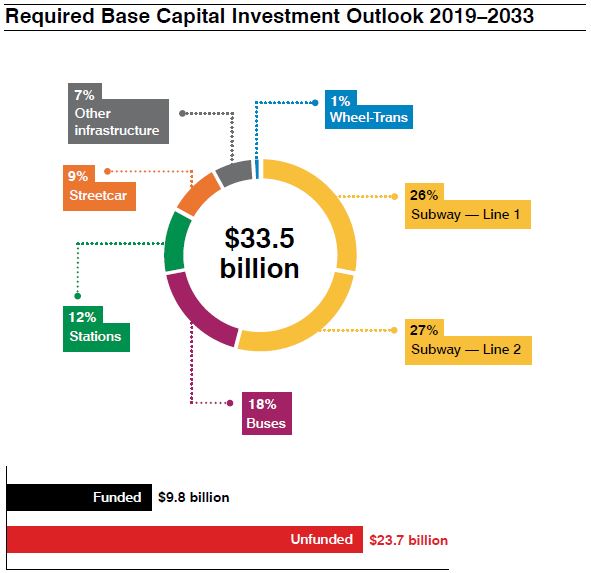

Seen from a high level, the $33.5 billion plan breaks down like this:

Of the “funded” portion, about one third depends on assumptions regarding available funds from various sources in the second decade of the plan, and the remainder is based on the current known commitments of various government. This is less than certain with provincial plans to take over ownership of the subway system and responsibility for funding its capital maintenance. Note that in the chart above, 65% of the total is subway related. This would leave Queen’s Park on the hook for $22 billion over 15 years, and that does not pay for system expansion.

(For clarity, some of the spending included above is on works in progress such as the ATC signalling on Line 1 YUS, and the delivery of new streetcars. Only the costs in 2019 and forward are included in the figures here.)

Funding vs Financing

This report deals with the funding needs of the transit system. The distinction is often blurred between getting the money (funding) and paying for it (financing). The distinction is that if you buy a car, somebody (you, or more likely your bank) pays for the vehicle. The dealer and the automaker are happy, but you now have a debt. That’s “financing”. A slightly more creative scheme would be for you to rent the car so that someone else (a leasing company) actually owns it, but this is still “financing”. Real money changed hands somewhere, although the leasing company would get a better price on a fleet purchase, and they have tax write-off opportunities that you probably don’t.

Money could come from outside investors who may simply provide financing secured by future revenues (taxes on new development, for example), or might build or buy and even operate assets on our behalf. But one way or another, we have to pay for them unless new money with no strings attached appears out of thin air. That’s how one-time grants for major projects like subway extensions work. Governments give the TTC money with which to build new lines, but the cost stays on the government’s books and is not a future charge against the transit system. That’s a system the province doesn’t like one bit, and that is why Ontario wants to own and finance projects if only because the accounting looks better without that “gift” to Toronto.

There is a great debate over where we will find $33.5 billion, but there is no way to make that number vanish short of simply not undertaking the projects it will fund.

Continue reading

$33 Billion and Counting

A political tremour ran through the transit world in Toronto recently with the TTC’s release of a 15-year projection of capital spending requirements at $33.5 billion. This does not include funding for most system expansion projects beyond the already-approved Scarborough Subway.

That number is big, but it’s no surprise to those who have been following TTC budgets for years. A major issue has been that “unfunded” or “below the line” projects don’t get the attention they deserve and are deliberately kept off of the books to reduce the apparent size of the City’s financial problems. Common tactics included omitting projects from the overall budget, or projecting their spending in a period just beyond the rolling ten-year horizon of capital planning.

Transit planning in Toronto and at Queen’s Park is reckless when it downplays the backlog of spending and associated subsidies facing public agencies. New spending and the inevitable photo ops for grinning, back-patting politicians are easier to fit into plans when you can ignore the transit system crumbling in the background.

Several budget reports will be before the TTC Board (and later at City Council) at its next meeting on January 24, 2019.

There is far too much material here to review in a single article, and so I will break this up over multiple posts. Some of the details behind individual projects will not be available until I obtain the full version of the Capital Budget known as the “Blue Books” which expand the line items from the “Blue Pages” into project descriptions and schedules.

A vital part of the new reports is a shift to a longer time frame (15 years) and the inclusion of all projects in the Capital Plan whether they have funding or not. The extent of the problem is quite evident in the following chart. The purple hatched area shows the requirements for coming years while the sold areas show known funding amounts in the medium term and hoped-for income thereafter.

The big drop in the City’s funding share in the early 2020s arises from the lack of borrowing headroom in the overall City budget. A big problem here is the crowding by major projects such as the Scarborough Subway Extension and the Gardiner Expressway rebuild within the overall borrowing plan. Current City policy dictates that the average debt servicing cost should not exceed 15% of City tax revenue over a ten year period. Planned spending in the next few years will eliminate the headroom for additional borrowing. This exactly coincides with the bulge in TTC capital requirements beginning in 2022. To put it another way, if funding continued at 2019 levels across the chart, there would still be a shortfall, but against a much higher base.

Even this chart does not tell the full story because the Capital Plan continues to push major projects beyond the ten-year line, and the financial pressures from system expansion are not fully accounted for here. As things stand today, less than 30% of the ten-year program is funded. Beyond 2028, the level of assumed funding is still well below historical levels.

($ billion) 2019-2028 2029-2033 Total 2019-2033
Funded $6.4 $3.4 $9.8
Unfunded $17.5 $6.2 $23.7
Total $23.9 $9.6 $33.5

System expansion projects will add a further $3.8 billion over the first ten years of the plan:

  • Line 2 Extension (formerly known as the SSE): $3.4 billion (subject to revision when an updated cost report is presented to Council in April 2019).
    • “While the 10-Year Capital Plan includes $3.360 billion in funding for this project (between 2019 to 2028), this project has an overall budget of $3.560 billion. This estimate, which includes $132 million to extend the life of the SRT until the Line 2 East Extension commences operation and a further $123 million to decommission and demolish the SRT, was based on 0% design. The project budget and schedule will be re-baselined in Stage Gate 3 report to City Council in April 2019, factoring in delivery strategy and schedule risk analysis.”
  • Relief Line South: $385 million will be spent in 2019-20 to support early works on this project. Some of this is already funded, but $325 million is being advanced into the current ten-year budget. Of this, the City proposes to provide half and looks to other levels of government for a contribution. The actual RL construction project is a separate entity which is not yet in the budget.
    • “The 10-Year Capital Plan includes funding of $385 million to complete current work only, which includes completing the preliminary design and engineering to between 15% and 30% complete, including developing a project budget and schedule.”
  • Waterfront Transit: The ten-year budget includes only $27 million in 2019-21 for design work on the planned extension from Exhibition Loop to the Dufferin Gate. Design work on any other Waterfront projects, let alone any construction, remains beyond the ten-year window.
  • Spadina Vaughan extension: Outstanding work on this project including close-out costs amount to $60 million in 2019, but this will be funded within the existing project.

[Quotations above are from the 15 Year Capital Investment Plan and 2019-2028 Budget, pp 12-13.]

The Relief Line work includes tasks such as property acquisition, utility relocation and design for the tunnel boring equipment. Now that the line has political support, spending sooner rather than later is on the agenda, and about two years can be shaved from the original project schedule by doing the preliminary work now. This is a major change from the position taken by Mayor Tory during the election campaign, and the need to “do something” as soon as possible is now evident.

Continue reading
