On May 2, Toronto’s Executive Committee considered a report on the future bus service to replace the Scarborough RT which will shut down in late 2023. The “debate” was notable for a few key reasons:
- The staff report took the position that a busway in the SRT corridor was not on the table because it is not “funded” in City budget parlance. Therefore, the report concentrates on buses operating over city streets between Scarborough Town Centre and Kennedy Station.
- There was considerable confusion about the cost of the SRT busway option, although it has been under study by the TTC for a few years.
- Completion of the design to 30% lacks only $2.9 million in funding. The position of most Councillors and of staff is that the province should pay, and talks are underway as part of the wider Scarborough Subway funding arrangements. Meanwhile the design work sits.
- The Committee was misled by City staff about the busway’s cost by confusion of busway-specific costs with other elements such as the eventual dismantling of the SRT which is a common cost for any scenario.
- Several City staff appeared to have done little prep work for the debate even though it was well known in advance that this would an item of interest on the agenda.
Meanwhile, the hapless transit riders in Scarborough wait for a fast route to replace the SRT, but see this drifting off into the mist. There is a strong sense that this project is not a priority for the City unless someone else pays. That may sound very good as a negotiating stance, but it does little for riders.
This article reviews the estimates for the busway to sort out the confused material presented to Executive Committee. Possibly, if the planets all align over Scarborough, Council can unscramble this at its meeting on May 10.
Line 3 Bus Replacement Study Final Recommendations

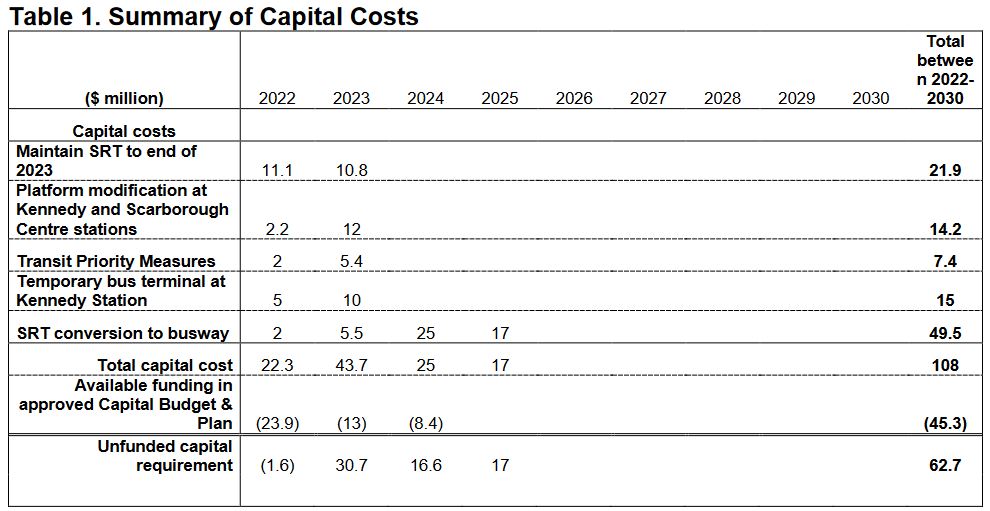

In April 2022, the TTC Board approved management’s recommendation that the SRT bus service operate over a busway to be built in the existing SRT corridor between Ellesmere and Kennedy Stations. The table below summarizes the capital costs.

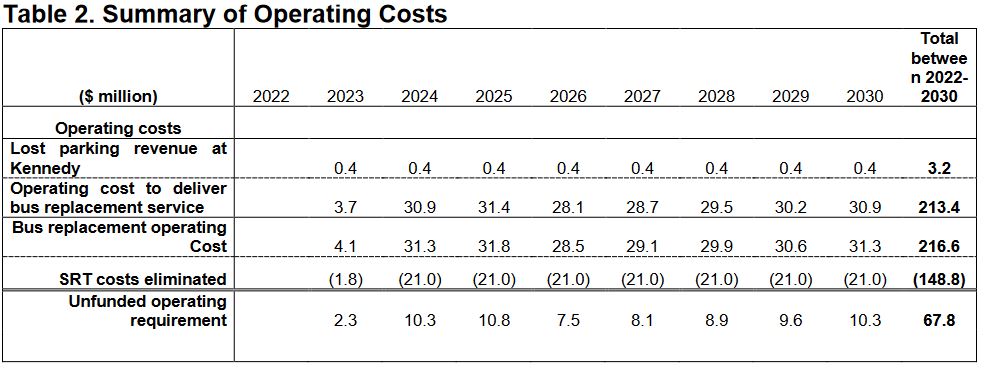

The total cost from 2022-2030 is $108 million, but only $49.5 million of that is due to the busway. Of that $2 million would be spent in 2022. Other costs have nothing to do with the busway option and will be incurred regardless of which option is chosen. This leaves an unfunded requirement of $62.7 million of which the lion’s share is due to the busway.
The report explicitly states that this cost includes demolition of the existing infrastructure, a cost that will have to be incurred whether buses run in this corridor or not. The dollar value of this work is not split out.
The next table shows operating costs for the replacement bus service.

There is a small loss of revenue because the temporary bus terminal at Kennedy will occupy space now used for parking. This foregone revenue is common to any option chosen for the bus link to STC.
The cost of bus replacement service is low in 2023 because it will not begin until November, then jumps up to a full year of operation in 2024. This would be done over city streets because the SRT busway cannot be opened within 2024. However, there is only a small rise in cost in 2025, well below inflation, and then a drop in 2026. This represents the saving of about $3 million annually because of shorter travel times via the busway. Without the busway, the total for 2023-2030 would be about $21 million higher.
There is an offsetting drop in costs thanks to the SRT shutdown which saves about $21 million annually. Note that the figures above are the same in each year, and the saving would probably be higher due to inflation. This shows as a “credit” of $148.8 million, although it is not real, spendable money, merely a reduction in future costs. The net increase in operating cost is $67.8 million. Without the busway this figure would rise to about $89 million.
In this and other estimates, there is a separate large future expense to demolish the existing SRT structure. Although this might be repurposed as a Scarborough “High Line”, from a budgeting point of view provision must be made for its removal absent any other committed plan. The cost of this work is $150-175 million, and that cost will exist regardless of which bus routing option is chosen. City staff mingled this very large cost with the discussion of the busway, and that misled the Committee about the eventual busway cost.

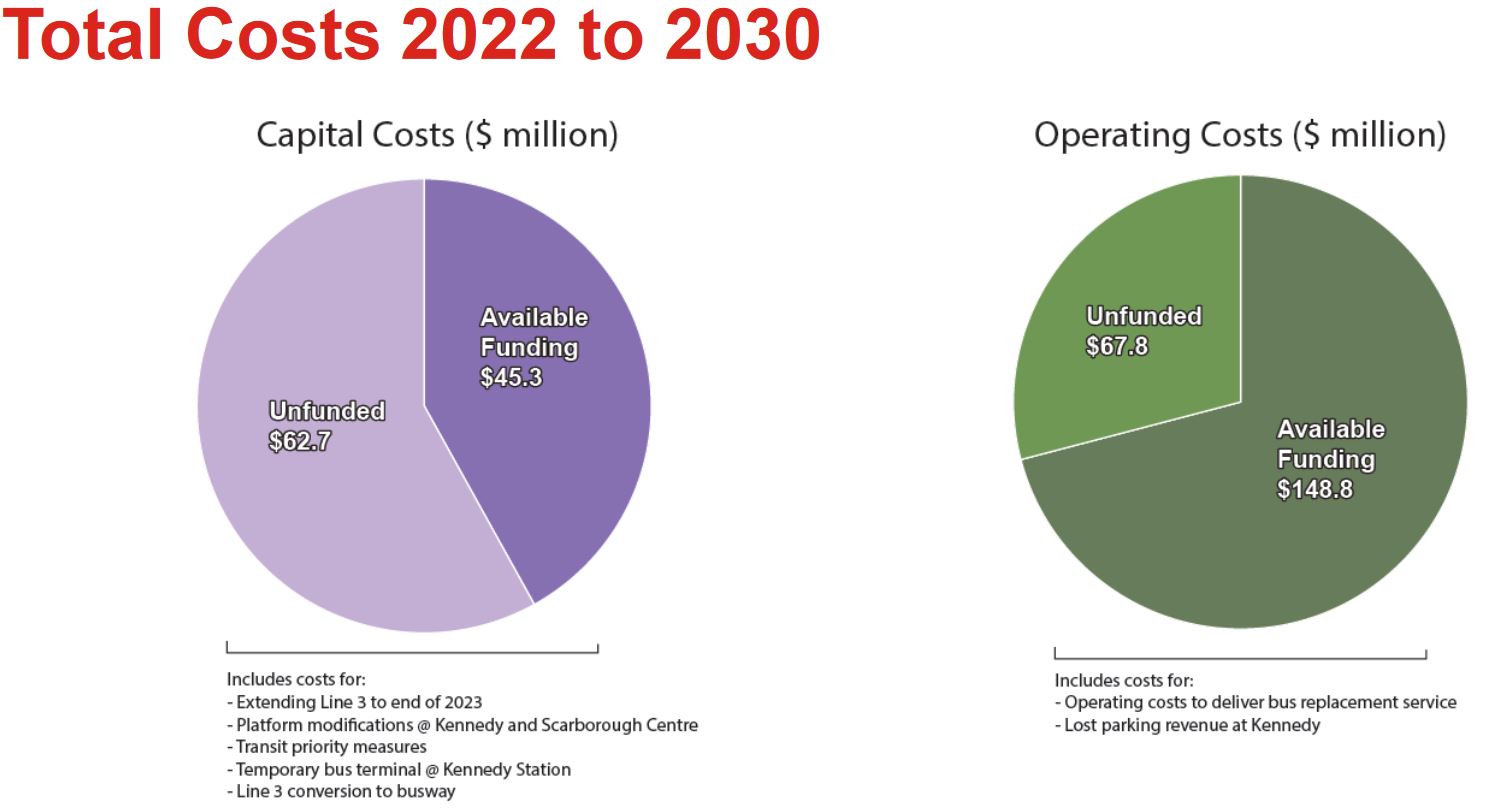

The pie chart below appears in the presentation deck provided with the report. The capital chart on the left mirrors Table 1 above with a total cost of $108 million of which $62.7 million is unfunded. However, I must repeat that only $49.5 million of this is due to the busway and the remainder is an unavoidable cost related to the SRT shutdown.
On the operating side, the avoided cost of running the RT of $148.8 million is treated as available spending headroom. The remaining $67.8 million is the amount needed to fully fund the bus operation, but this assumes the savings of the SRT busway from late 2025 onward. The gap would be larger without the busway in place.

Transit Network Expansion Update
This report from February 2023 notes among many other items that the projected cost of the busway has risen from the earlier estimate in 2022 to $58.6 million, or $9.1 million more. This is a recent report and so the estimate must be treated as current.
Again the report states that the cost of demolishing existing infrastructure is included in this price.
As stated in the April 14, 2022 Board report titled, Line 3 Bus Replacement Study Final Recommendations, it is recommended that parts of the existing Line 3 be converted to a right-of-way (ROW) for bus operation in order to provide customers with the fastest and most reliable bus replacement service. The updated total estimated capital cost for this is $58.6 million (Class 4 estimate). It includes the construction costs to remove existing track infrastructure and systems for the trains; costs to assemble required property for the busway and bus stop platforms; and costs to install new pavement to allow buses to
operate.
Financial and Major Projects Update for the Year Ended December 31, 2022
From the Executive Committee debate we know that the TTC requires $2.9 million to complete the 30% design for the busway and hence have a solid estimate with which to seek funding. Work has stopped because this money is not available.
However, that stoppage must be viewed in light of a general slowdown on capital spending that was implemented to reduce the TTC’s call on City funds in 2022.
According to the Major Projects Update from April 2023 [p. 1]:
Of the total 2022 capital underspending of $259.5 million, $87 million is directly attributable to the paused spending of capital projects necessary for the TTC to contribute towards the City’s $300-million COVID-19 Backstop Funding Plan.
Later in the report [p. 23] we learn
[…] some design work related to the SRT Transition (Bus Replacement Infrastructure) progressed slower than anticipated, resulting in underspending of $2.2 million for that capital work.
Whether this “slower” work was a result of complexity or available workforce, or if it was part of the contribution to the City’s capital crisis, we do not know. Clearly, however, most of the money needed to finish the design was in the 2022 budget originally, and if necessary could have been carried over into the 2023 budget, a common practice for multi-year work.
A Confused Debate About Funding
During the Executive Committee debate, nobody simply asked “can we find $2.9 million somewhere to get the design work done”. As long as this sits unfunded while the City and Province grind through political and legal agreements, the actual construction will be further delayed.
With a question about operating costs, the committee tiptoed up to asking about cost tradeoffs, an obvious tactic especially considering that the TTC’s 2022 report was based on this approach. But, no, this was not to be. Councillors were left with the impression that the busway would be at least $58 million, possibly much more, and the issue of operating savings was ignored.
Finally, the question of service quality for riders did not receive much attention. This is rather sad considering the billions in capital spending on rapid transit projects that has been justified on the premise that saved travel time has a value. It does not accrue to the City, but has a value to the riders, and contributes to the attractiveness of transit service, something the City claims to be of great concern.
Throughout all of this, there was clear confusion among Councillors who are unfamiliar with the details of the file, and among staff who should have arrived at the meeting fully up-to-speed on what was expected to be a major item. Saying “we will get back to you” is simply a recipe for further delay, and strongly implies a lack of urgency. Some questions could have been addressed by a direct report to Council rather than waiting through an entire meeting cycle to the next Executive Committee meeting.
I was left with the sense that haggling with the Province over cost sharing took higher priority than finishing a credible design, one that will save future operating costs and speed buses on the SRT corridor. City Council should amend the Executive Committee’s position and direct that funding be located within the capital budget to complete the design. It is ludicrous that politicians who claim to be ever so worried about Scarborough constituents are perfectly happy to make them wait longer for the SRT bus option that will so clearly benefit every rider.
What’s going to happen with the SRT corridor after the trains are gone? Are the tracks staying where they are, rusting away? Likely they’ll have to recycle the tracks anyways, and fill in any depressions. Will they have to pave the corridor for bicycles and/or joggers? Would they be doing that now or later?
Will they remain like the old Roman roads as an monument to Bill Davis?
Steve: Er .. ah .. the whole idea is to replace the tracks south from Ellesmere with a bus roadway. However the elevated structure is another matter. Maybe it could be a Scarborough Henge used to predict momentous occasions like the opening of Line 5 when the sun lines up with the columns.
