Subway and Streetcar Major Works and Closures 2024

At its January 24 meeting, the TTC Board received a report and presentation on maintenance work and closures planned for the subway and streetcar system in 2024, plus a preview of 2025.

The report has long tables of events organized by date, but to make things a tad easier to find, I have grouped items by affected area in this article.

Subway closures come in various flavours with the most disruptive being full weekend for major work such as replacement of turnouts (switches and frogs) at junctions such as centre track entrances/exits and leads to yards, or renovation works that cannot be completed in an overnight shift. Other works only require early closing of a line to allow for a longer work shift.

All dates shown below are subject to change, but the schedule gives a sense of the timing and amount of work. (SSE) and (OL) refer to works for the Scarborough extension and Ontario Line respectively.

There are no projects planned on Line 4 Sheppard.

Riders may have thought that the end of the Line 1 Automatic Train Control (ATC) project and the near completion of Line 5 Crosstown might have brought a reduction in subway closures. However, a large amount of track and structural repair in 2024 consumes much of the calendar. This is particularly true for the Spadina branch of Line 1, and the east end of Line 2 which is also affected by both the Ontario Line and the Scarborough Subway Extension.

On the streetcar system, riders in Parkdale will face changes to 504 King, 501 Queen and 63 Ossington for most of the year while water main and track repairs occur on King from Shaw to west of Dufferin. In the east, there will be work for the Ontario Line that will close Queen Street for brief periods. There are many projects for overhead reconstruction as the pantograph conversion progresses from an interim to a final state, but the TTC has not revealed which of these will trigger diversions, and which can be handled under service with off-hours work. Construction of the 501 Queen Ontario Line diversion downtown is planned at a glacial pace extending to Labour Day.

No diversions/substitutions have been announced for any of the streetcar projects.

Subway 2024

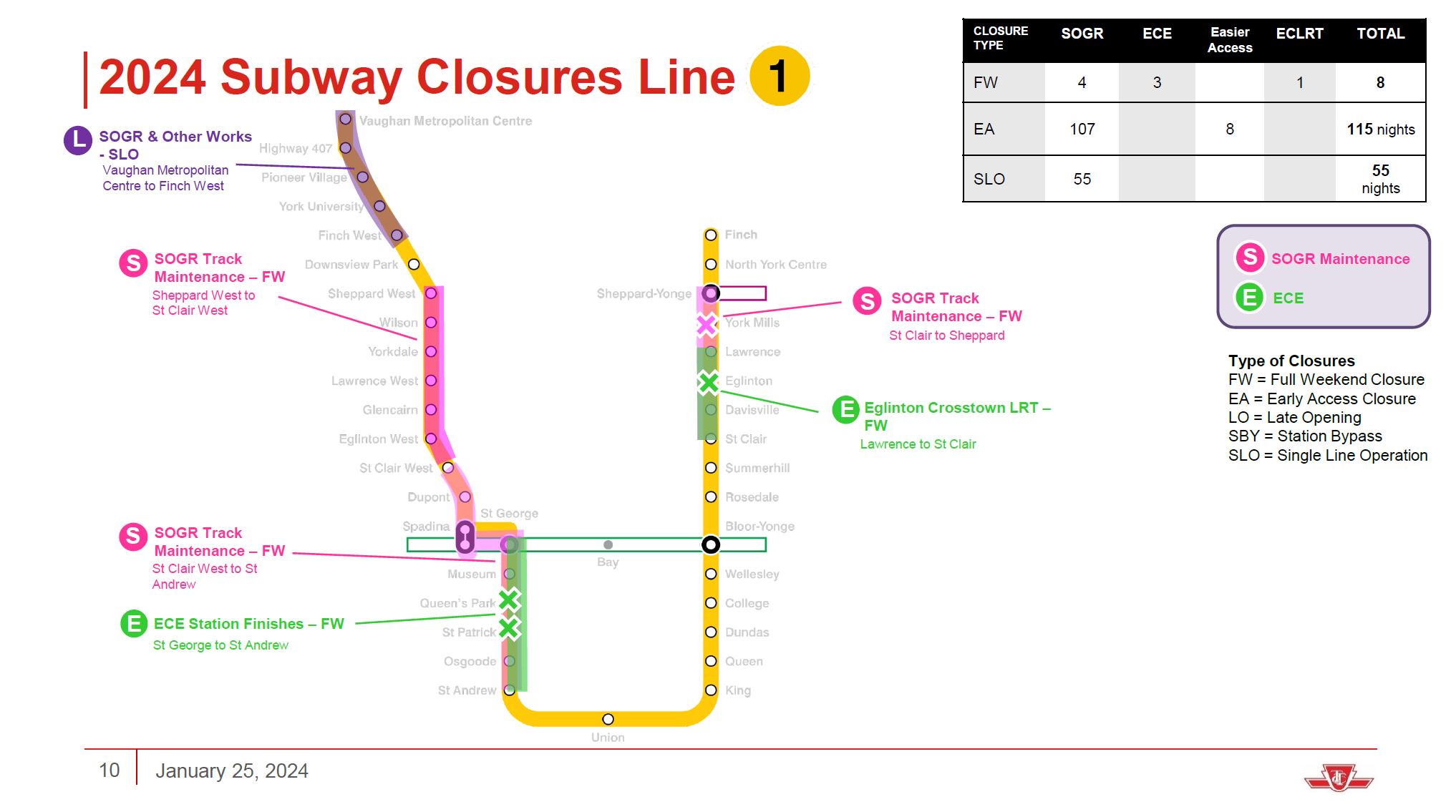

Line 1 Yonge University Spadina

Vaughan MC to Finch WestLate Evening Single Line Operation
Communications equipment installationFeb 12-16
Line 1 Capacity Enhancement Program
Installation of mounting hardware for communications equipment
Leak remediation
Mar 25-28, Apr 1-6, Apr 29-May 4, June 17-22, July 20-25, July 29-Aug 3, Sept 16-21, 23-28, Oct 7-12, Nov 4-9
Sheppard West to St. Clair West
Major maintenanceEarly closing on June 10-14, 17-22, 24-28
Weekend closing on June 22-24
Lawrence West to St. George
Major maintenance and rail replacementEarly closing July 15-19, 22-26
St. Clair West to St. Andrew
Double concrete tie replacementEarly closing July 9-13
Major maintenanceWeekend closing July 13-15
St. George to St. Andrew
Station finish work on University SubwayWeekend closing Jan 13-15 and 20-22, Feb 10-12
Osgoode to College
Major maintenanceEarly closing July 29-Aug 2, Aug 6-10, 12-16
College to St. Clair
Open cut maintenance, rail and tie replacementEarly closing Sept 16-20, 23-27, Sept 30-Oct 4
St. Clair to Sheppard-Yonge
York Mills double crossover (centre track) full turnout replacementEarly closing on May 13-18, May 27-June 1, June 3-7
Weekend closing on May 18-20 and June 1-3
Davisville platform rehab and asbestos abatementEarly closing May 6-10, 13-18, May 27-June 1, June 3-7
Lawrence Easier AccessWeekend closing May 18-20 and June 1-3
St. Clair to Lawrence
Line 5 work at Eglinton StationWeekend closing Jan 27-29 (actual south limit was changed to Davisville).
Eglinton to Sheppard-Yonge
Asbestos abatementEarly closing Nov 4-8, Dec 2-6, 9-13

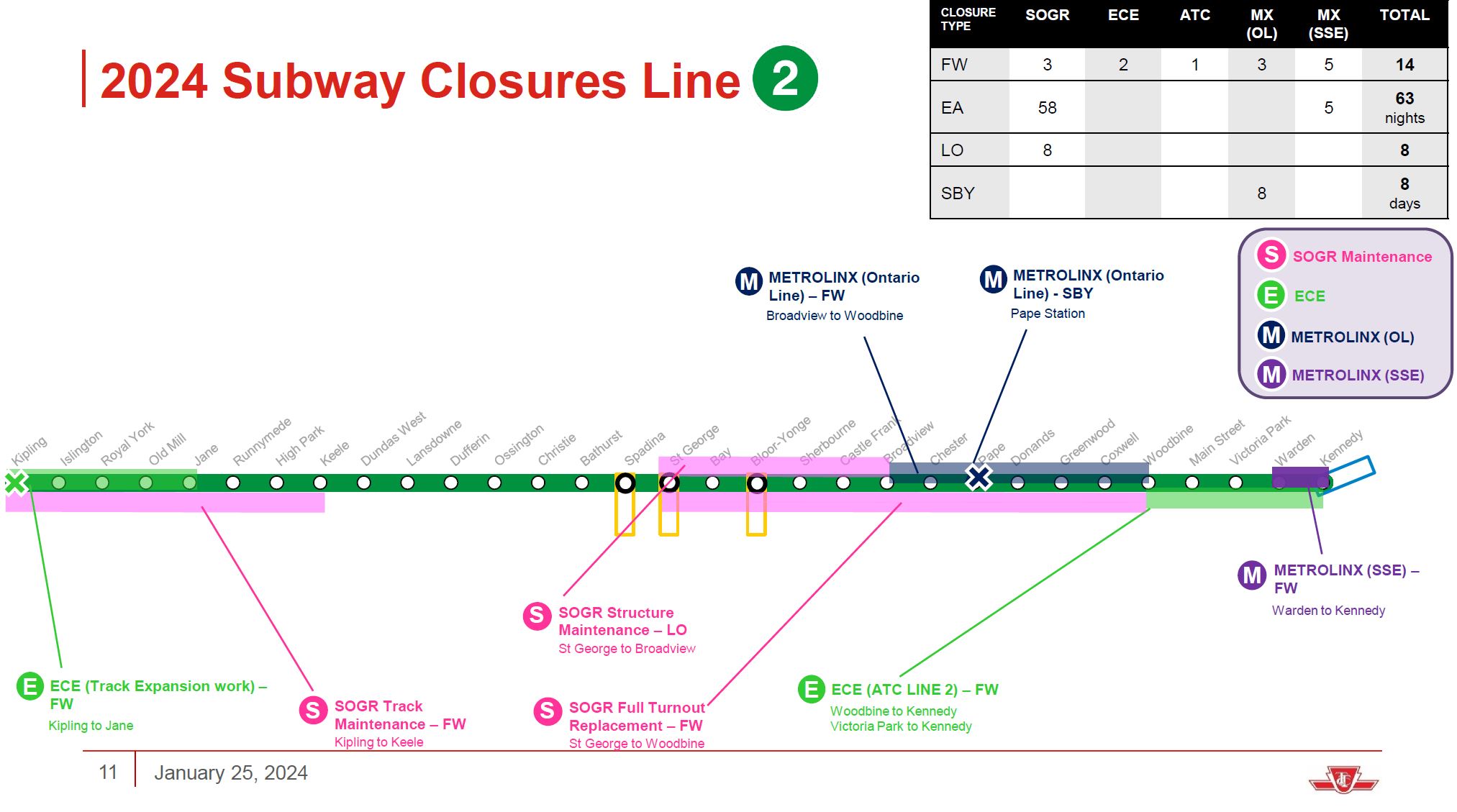

Line 2 Bloor Danforth

Kipling to Jane
Turnout installation and signalling for third track at KiplingWeekend closing on June 15-17, Sept 21-23 and Dec 7-9
Kipling to Keele
Rail replacementWeekend closing Dec 7-9
Jane to Ossington
Tie replacements and tampingEarly closing Nov 25-30, Dec 2-6, 9-13
St. George to Woodbine
Chester full turnout replacementWeekend closing on Apr 6-8 and 20-22
Early evening closing on Apr 1-6, 15-20 and 22-26
St. George to Broadview
PE Viaduct beam replacementsLate openings on Apr 7 and 21, June 2 and 9, July 7 and 28, Aug 11, Sept 29
Broadview to Woodbine
Force main relocation (OL)Weekend closing Apr 20-22 and June 8-10
Tunnel ventillation modification (OL)Weekend closing July 6-8, Aug 10-12
Pape
Force main relocation (OL)Station bypass Apr 13-15 and 27-29, June 22-24, July 27-29
Woodbine to Kennedy
Line 2 Automatic Train Control early works
Installation/relocation of drainage pipe, conduits, etc.
Weekend closing
Apr 13-15, May 25-27, Oct 26-28
Victoria Park to Kennedy
Warden double crossover full turnout replacementEarly closing
Oct 15-19, 21-26, Oct 28-Nov 1, Nov 11-16, 18-22, 25-30, Dec 2-6
Weekend closing
Oct 26-28, Nov 16-18, Nov 30-Dec 2
Warden to Kennedy
Line 2 Automatic Train Control early worksWeekend closing Feb 3-5
Installation/relocation of drainage pipe, conduits, etc. (SSE)Early closing May 24-25
Drainage repairsEarly closing Oct 15-19, 21-26, Oct 28-Nov 1, Nov 11-15, 25-29, Dec 2-6
Demolition of existing box structure (SSE)Early closing Oct 25-26, Nov 15-16, 29-30
Weekend closing Oct 26-28, Nov 16-18, Nov 30-Dec 2

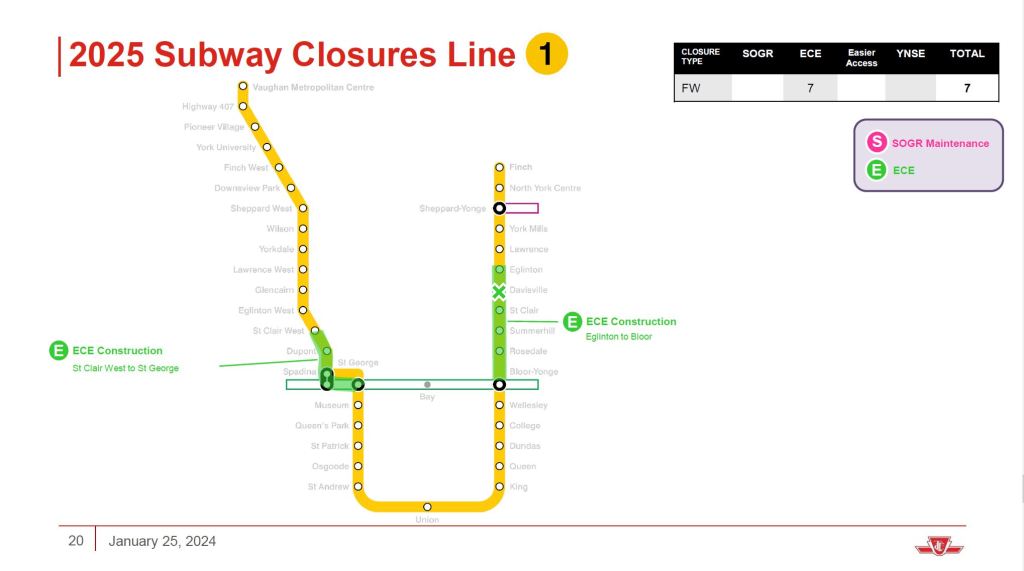

Subway 2025

The maps of 2025 closures show very little of the work that is likely to occur by comparison with 2024.

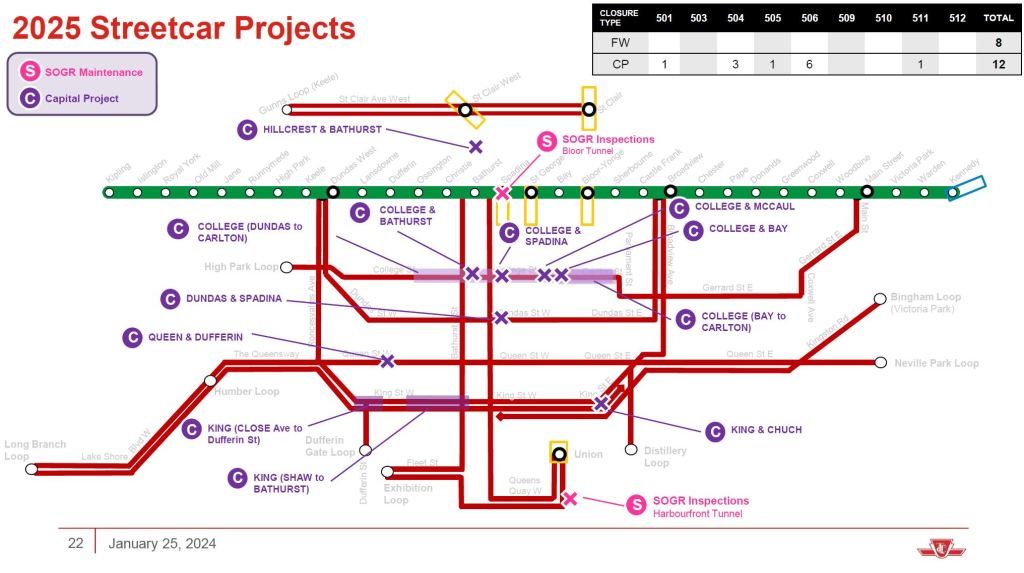

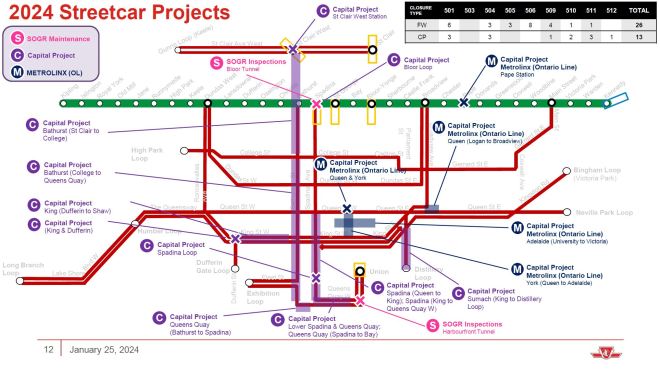

Streetcar

The list in the report is in date sequence, but I have reordered it here by affected route. Details of replacement services have not been announced.

501 Queen
Overhead inspection:
Nightly diversions
McCaul Loop Apr 2-5
Queen & Bathurst Apr 8-10, July 29-30, Nov 4-5
Neville Loop Apr 16-17
Queen & Dufferin May 6-7
Kipling & Lakeshore Oct 16-17
Car stop replacement:
Weekend closing
Queen & Waverley: June 21-24
Queen & Beaconsfield: July 5-8
Rail grinding:
Nightly diversion
Parliament to Sherbourne: Oct 6-8
Willow to Neville Loop: Oct 8-10
Noble to Brock: Oct 15-16
Lakeshore from Fleeceline to Albert: Oct 16-19
Brookfield to Northcote (To be confirmed): Oct 21-24
501 Queen / 503 Kingston Rd
Track margin and rail repairs:
Weekend closing
Queen at and east of Broadview: May 17-20
Queen at and west of Church: Dec 6-9
Queen & DeGrassi underpass (OL)June 24-27 Overhead inspection (Nightly diversion)
June 28-29 Overhead de-energized at DeGrassi (OL) (Route diversions)
June 28-July 2 Logan to Broadview closing
July 2 Power restored
Sept 24-27 Overhead inspection (Nightly diversion)
Sept 27-28 Overhead de-energized at DeGrassi (OL) (Route diversions)
Sept 27-Oct 1 Logan to Broadview closing
Sept 30-Oct 1 Power restored
504 King / 501 Queen / 508 Lake Shore
Water main and track repairs on King from Dufferin to ShawDiversions from Feb 18 to Dec 21
King & Dufferin intersection replacement June 23-July 27
Atlantic Ave underpass overhead inspection: June 25-26
King-Queen-Roncesvalles Overhead inspection: July 2-3 (Nightly diversion)
504 King
Car stop replacements: Weekend diversionKing & Portland: Apr 26-29
Rail Grinding: Nightly diversionPortland to Spadina: Oct 28-30
Overhead inspection: Nightly diversionsDundas West Station: May 21-22
Dufferin Loop: July 3-4, Nov 19-20
King & Bathurst: July 8-9, Nov 18-19
Adelaide underpass: July 30-31
Broadview Station: Aug 6-7
Broadview from Queen to DundasTrack margin repair: Weekend closing May 24-27
Overhead reconstruction: July 23-Aug 9
504 King / 503 Kingston Road
Car stop replacements: Weekend diversionKing & John Apr 5-8
Intersection overhaul: Weekend diversionKing & Church: Aug 9-12
Overhead reconstructionKing from Parliament to Sumach: June 24-July 12
Sumach/Cherry from King to Distillery Loop: July 28-Aug 19
505 Dundas
Intersection overhaul: Weekend diversionDundas & Parliament: Aug 16-19
Rail repair: Weekend closingDundas & Dovercourt: Oct 11-14
506 Carlton
Yonge & College traction power cable relocationNightly diversion Jan 8-11
Rail repairs: Weekend closingCollege & Gladstone: Apr 12-15
Coxwell & Upper Gerrard curve: May 27-June 7
Gerrard & Bowmore car stop: May 31-June 3
Gerrard & DeGrassi car stop: July 26-29
College & Montrose car stop: Oct 4-7
Howard Park E of Roncesvalles (margin repairs): Nov 1-4
Gerrard Logan car stop: Nov 29-Dec 2
Overhead inspection: Nightly diversionMain Station: July 4-5
Gerrard & Carlaw: Nov 29-30
509 Harbourfront / 510 Spadina
Tunnel overhead and track inspection Weekend closing Feb 16-19, June 7-10, Sept 27-30, Nov 8-11
Overhead reconstructionQueens Quay from Bathurst to Bay: Oct 25-Dec 20
510 Spadina
Bloor Spadina
loop inspection
Nightly diversion Jan 22-25, Feb 20-23, Mar 18-24, Apr 22-26, May 13-16, June 10-13, July 15-18, Aug 13-16, Sept 16-19, Oct 21-25, Nov 25-28, Dec 9-12
Weekend closing Mar 1-4
Overhead reconstructionQueen to Queens Quay: May 12-June 22
Bloor Spadina Loop: July 28-Oct 5
Bloor to College: July 28-Aug 29
Spadina Circle: Aug 30-Sept 16
College to Dundas: Aug 10-27
Dundas to Queen: Aug 28-Sept 16
SOGR work at Spadina Station: July 28-Sept 20
511 Bathurst / 509 Harbourfront
Overhead inspection: Nightly diversionBathurst & Fleet, Fleet Loop, Exhibition Loop: Apr 1-4
Bathurst Station: July 24-25
Overhead reconstructionSt. Clair to College: Sept 1-Oct 5
College to Queens Quay: June 23-July 27
Bathurst & Fleet: Sept 1-Dec 22
Fleet Loop: Oct 2-31
Rail repair at RichmondWeekend closing July 12-15
Rail grinding at Exhibition Loop WBNightly diversion Oct 30-Nov 1
512 St. Clair
St. Clair West StationReconstruction: Jan 7-May 11
Overhead inspection: Nightly diversionAug 26-29, Oct 7-11
Miscellaneous
Ontario Line
Queen Street diversion
York & Adelaide: June 6-July 19
University to Victoria: June 7-July 15
Queen to Adelaide: July 9-Aug 16
Queen & York: July 22-Aug 19
York & Richmond: Aug 20-Sept 6
Hillcrest
Overhead reconstruction in yard
June 19-Jan 11
Leslie Barns Access
Overhead reconstruction
Leslie Street from Commissioners to Queen: June 24-July 22
Russell YardOngoing reconstruction Oct 27-Dec 31
Coxwell south of Dundas
Rail repair:
Weekend closing Nov 8-11
