A Don Mills Subway For Toronto

This is a companion article to one of the same name on the Torontoist website in which I argue that Toronto should have a subway line from Front & Spadina to Eglinton & Don Mills.  Formerly known as the “Downtown Relief Line”, this should be called the “Don Mills Subway” and there should be no pretensions about it stopping at Danforth.

Drawing subway lines on maps, especially for the DRL, has been a cottage industry among transit advocates and city watchers for several years, and everyone has their preferences.  I have stayed away from that territory most of the time because the torrent of comments (including a long thread on this side) is more than I care to moderate.

However, the Don Mills line needs advocacy and a good indication of what it might look like to counter the “downtown has enough subways” drivel dished out by Mayor Ford.

My proposed alignment is not intended to be definitive although parts of it are locked down to make specific connections and to take into account physical constraints on the route’s placement.  Other alignments are possible in places, but I don’t want to revisit that discussion in excruciating detail when the basic purpose is to show what a new line could achieve.
Continue reading

Measuring Service Quality

The quality of service provided on Toronto’s streets and in the subway has been a major, long-running topic on this site.  As reported last week, the TTC has just issued its third quarterly report on surface route reliability relative to a target of scheduled headway ±3 minutes.  They acknowledge that the methodology behind these numbers is flawed, and seek a better way to track reliability from the riders’ point of view.

To that end, the TTC is looking at the “journey time metric” used in London, UK, which tracks an entire trip’s experience including access, waiting and transfer times.  Leaving aside the need to define multiple trips both in location (downtown, suburban, in between) and in time (peak commutes, midday, evening, weekends), I believe that multiple metrics are required to flag problems at a level that is both meaningful and revealing of problem specifics.

What follows is a slightly reworked version of a proposal I made to the TTC recently on this subject.

Continue reading

Updating TTC Wayfinding

This article has been split apart from the coverage of the October TTC Board meeting to accommodate updates and to keep the comment thread separate from other issues.

The Board considered a presentation entitled New Wayfinding Standards which, among other things, proposed a change in naming for subway lines to the use of numerals.  This has provoked no end of comment, some on this blog, as an ill-advised waste of money.

More to the point, this presentation is neither a “standard” nor a comprehensive review of TTC wayfinding.  It is an overview of a few changes, and even these are not set out on a thorough basis.  What we have here is a proposed trial, but not a systemic review of wayfinding.

The goals are simple: avoid multiple styles of signs, convey information in a consistent way so that riders know the “language” of the signs across the system, make maps easier to understand, and make all forms of wayfinding more accessible.  One style, one letter font, one style of branding should identify a “TTC” message wherever it appears.

Consistency and legibility are not important just for the casual user, but for the regular passenger who  may be in an unfamiliar part of the system.  They may walk through their “home” station on auto-pilot, but off of their regular territory, they too will be “tourists”.

Continue reading

TTC Board Meeting October 23, 2013 (Update 3)

Updated October 26, 2013 at 5:20 pm to reflect discussions at the meeting.

The TTC Board met on October 23.

Update: The 2014 Operating and Capital Budgets are still not public, and they may now  appear in November (this has yet to be confirmed).  This is unusual because under Mayor Ford, the budget process for the City has been moved up so that the overall budget can be finalized early in the new year.  In 2012, the TTC budgets for 2013 were on the September agenda.

Will the TTC roll over again and accept a flat-lined subsidy placing the entire burden of extra costs on riders through fare hikes and compromises on service quality, or will they finally argue for better subsidies and force Council to debate just what transit should be doing – aside from building one subway line – for Toronto?

The CEO’s report (below) offers a hint in this statement:

“… discussions with the City continue regarding the TTC Operating and Capital Budget submissions for 2014-2023.  I am resolute in expecting an increase in subsidy to accommodate and service ever increasing customer numbers.”  [page 5]

Does this represent a strategic position on the TTC’s part, or division among the Commissioners about the direction the organization should take?

The City of Toronto will launch its 2014 budget process formally on December 2, 2013.

New Wayfinding Standards

Recent reports in other media have talked of a proposal to rename the subway lines with numbers to simplify wayfinding information for riders.  The details of this and other schemes to overhaul information will be presented at the meeting.

Updated October 23 at 10:55am:  The presentation is now online linked from the title above.

Updated October 26 at 5:00pm:  This topic will be split off into a separate thread given the volume of comments, and the accumulated comments will be moved to the new thread.

CEO’s Report

The CEO’s report has little new relative to the September edition.  Riding continues to be above 2012 but below budget.  For reporting period 8 (mainly the month of August), riding was up 3.5% over 2012.  On an annualized basis, riding is up 2.8%.  These results are 0.1% below budget for the period, and 0.5% below budget for the year to date.

Total ridership for 2013 is projected to be 527m, 1m below the budget projection.  This shortfall, coupled with higher-than-expected sales of passes versus token/cash fares, will mean revenue will fall $7.6m below budget.  This will be counterbalanced by various swings plus and minus on individual expense lines (details on page 24).

Update:  According to CEO Andy Byford, the lower ridership and revenue numbers for 2013 are mainly attributed to the severe weather and floods earlier in 2013.  Major shutdowns planned for 2014 will definitely affect ridership and this will be built into the budget estimates.

Subway punctuality on the Yonge-University line remains a problem particularly in off-peak hours.  It is unclear how much this is a side-effect of the yardstick of headways within ‡3 minutes of scheduled values.  During peak periods, it is much easier to meet this goal because there are more trains on the line, and entire trips can be missing without headways going beyond the 3-minute rule.

The BD line problems occasionally from the transfer of trains to the Yonge line to “cover shortages”, although this is not explained.  Are there simply not enough working trainsets to operate the Yonge service, or are BD trains poached to fill major service gaps?

Update:  I have asked the TTC to clarify what this section of the report actually means.

As if the wait hasn’t been long enough already, the CEO’s report states that the Harbourfront line will not return to streetcar operation until August 2, 2014.  No reason is given for the further slippage between the July date given by Waterfront Toronto and the TTC’s new August date.

One major issue that the CEO’s report does not address is the fleet availability in Toronto.  Only through the shutdown of substantial chunks of the streetcar system has the TTC managed to field enough cars to cover what remains in operation.  It is in their interest to prolong construction projects until they can get the first of the new fleet on the road.  What was originally touted as a “spring” startup of LFLRV service may now well slip to at least “summer”.

Production deliveries of cars are supposed to start later this fall.  What is the status of this order?

Service reliability is supposed to be reported quarterly for all surface operations, but the third quarter report has not yet appeared (it is expected to show up sometime on October 21).  When it does, I will be reporting separately on comparisons of the numbers over the past three quarters of 2013.

Update:  The quarterly report was published on October 23 and has been discussed elsewhere on this site.

I will follow up on questions raised here with TTC staff at the meeting and will update the article when further info is available.

TTC Fare Policy – Requests For Fare Discounts

This is a compendium report on various proposals/requests the TTC has received for reduced fares for various groups.  The staff position is that any additional subsidies for various classes of riders must be funded through a policy decision at City Council with adequate funding through the subsidy stream to offset the projected revenue losses.

This has been the TTC’s stock position for such requests for years, but at least we now have a consolidated report listing the projected cost for each option.  If Council wants to fund new discounts, the expected cost is known presuming that we accept the TTC’s estimates (some of which are dubious).

  • Extending “Family Pass” (6 people, maximum 2 adults) pricing to the entire week.  This is projected to cost only $2.2-8.6m per year, although I am suspicious of the figure because it is based on existing pass sales.  If the pass is more attractive, then more of them will be sold, but the estimate does not take this into account.
  • Free off-peak trips for seniors.  The cost is estimated to be at least $22m per year based on the number of non-pass trips by students/seniors today (45.2m), subdivided by the proportion of seniors (40%) and then the proportion of off-peak trips (65%).
  • Off-peak only pass for seniors.  The technology to handle time-of-day passes does not exist on turnstiles today, and so this option would best be left until Presto is rolled out across the system.  The estimated annual cost is $1.0-2.1m, but this depends on various assumptions regarding pass pricing, trip counts and conversion rates from the existing all-day passes.
  • Lower age for “senior” passes to 60 from 65.  The estimated cost is $3.3-4.9m, but this includes only the lost revenue from existing Metropass holders switching to the lower-priced pass.  No provision is included for token users for whom the senior’s Metropass would be more attractive than continuing to pay single adult fares.
  • Extend senior/student fare pricing to ODSP and OWP recipients (these are the Ontario Disability Support and the Ontario Works programs).  This is projected to cost $6.3-12.6m, but the mechanism for administering these fares is not discussed.  Of particular note, the calculation is based only on the actual recipient numbers within Toronto, not on their dependents and spouses.

Any special fare regime will be easier to administer once automatic fare collection is in place.  Time-of-day discounts and special fares associated with a rider’s status can be build into the fare structure, and the actual amount of discount provided for each target group can be tracked.  This will be important if special subsidies are involved so that they remain separate budget lines rather than simply merging into the overall TTC revenue stream.

Advisory Committee Activity

An interesting read in recent TTC agendas has been the meeting minutes for the Advisory Committee on Accessible Transit (ACAT).  This is a very active group whose discussion cover a wide range of issues with TTC staff, and the minutes report their activities in detail.

One might wish for the Customer Liaison Panel to be as forthcoming with information on its activities.  It is unclear whether the CLP has done anything since its formation, or what its areas of focus might be.  If the panel is intended to represent “customers” as part of TTC activities, why doesn’t it show the rest of the world what it is doing?

Supplementary Agenda

Yorkdale Fatality of September 14, 2012 – Final Investigation Report

This report contains the detailed findings regarding an accident last year in which a work car struck two employees during overnight maintenance near Yorkdale Station.

[New] York University Station Construction Status

Councillor Perruzza addressed the Board on the issue of York University Station where, as reported in the National Post, the station excavation is a lake, and no work appears to be in progress.

According to TTC staff, the tunnel construction contractor, Obrascón Huarte Lain and FCC Construcción, has handed off the site to the station contractor, Ellis-Don, but this process has taken longer than expected.  Meanwhile, Ellis-Don did not take over pumping of water even though they were now responsible it.  This is to be corrected, and Ellis-Don will begin active work on the site in 2-3 weeks.

Construction at this location was substantially delayed due to a worksite fatality in 2012.

[New] Time-Based Transfers for Eglinton West

Commissioner Colle requested a report from staff on the implementation of a time-based transfer arrangement on Eglinton West during the Crosstown tunnel construction similar to the setup still in use on St. Clair Avenue.  The TTC will ask Metrolinx to contribute to the cost of this if it is implemented.

[New] GO/TTC Fare Integration at Dundas West and Exhibition Stations

Chair Stintz requested that staff report on the provision of a joint TTC/GO fare between Union Station, Dundas West and Exhibition Stations as a way of relieving demand on the system, notably on the 504 King car.  The report should be on the November agenda.

How Does The City Grow?

The October 22 meeting of Toronto’s Planning & Growth Management Committee saw the launch of the 2013 edition of a report tracking residential and commercial development patterns in the city.

How Does The City Grow Website

If anyone needs proof that downtown is the focus of development in Toronto, they need only look at the numbers in this report.

Development in the Greater Toronto Area is strong, but Toronto itself is taking a larger proportion of the total.  Across the GTA, dwelling unit completions have been on a long decline since a peak in 2002 while completions within Toronto have grown.  Toronto’s proportion of the total rises as a result with over 40% now located inside the City.

Grows13Fig1

City Planning tracks development applications within a five-year “pipeline” which allows for the long lead times between initial applications, approval, construction and occupancy of buildings.  This smooths out year-over-year variations, but also flags a turndown in future growth if the early stages of that pipeline start to dry up.  There is little sign of this happening up to the 2012 data, although the proportion of applications relative to the total rose slightly.

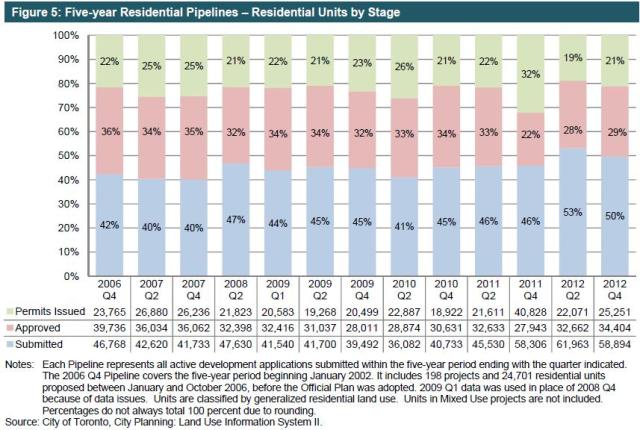

Grows13Fig5

The overwhelming type of new residential development is in the apartment form (this includes condo and rental projects).  This is not surprising considering that there is almost no vacant land in the city suitable for low-rise development on the scale we see in greenfield subdivisions outside of Toronto.

Grows13Fig4

New development is not evenly distributed across the city, but is concentrated in a few locations, notably downtown.

Grows13Tab3

During the five-year period 2008-2012, 41% of the proposed residential units were downtown.  This shows very strong market demand to live close to the core, but a related number is the 39% of proposed non-residential floorspace (GFA in the chart above) that is downtown.  Downtown commercial development in Toronto is, today, 25% of all such development in Canada.

Although City Planning puts a brave face on things, Table 3 also reveals the comparative failure of the “Centres” as planning mechanisms to focus development.  Only 8.7% of all residential and 3.5% of non-residential proposals are in the four centres: Etobicoke, North York, Scarborough and Yonge/Eglinton.  Scarborough Centre has almost no development planned at all.

The data presentation caused some confusion at the P&GM meeting when North York Councillor Filion compared the “38%” number for his centre with the numbers for downtown.  He was gently reminded that this was 38% of the 8.7% for all of the centres combined.

Where data consolidation does mask important details is in The Avenues, those major streets that are targets for future development, and in the “Other” category.

Almost one quarter of residential proposals are sited on The Avenues (the brown stripes in Map 1 below), but this is not broken down by city region.  Some areas have a great deal of development proposed and already built (many of the early projects in the 2008-2012 pipeline are already substantially completed), while other areas have nothing.  Are The Avenues actually directing development or simply endorsing what would happen naturally?

Grows13Map1

Almost 40% of non-residential development lies in “Other” areas many of which are designated employment zones.

The actual development patterns are clear in the overview maps (for full size versions of all illustrations here, please download the source document from the City’s website linked above).

Grows13Map2

Grows13Map5

The growth of downtown residential population is not tracked in this report, but a few comments at recent meetings give some indication of what is happening.  Cllr. Vaughan spoke of the development pressures in the Entertainment District where the population has gone up 125% in the past four years.  At a recent briefing on the Gardiner Expressway, Deputy City Manager John Livey noted that the population of Planning District 1 (downtown from roughly Dundas to Lake Ontario) has tripled between 2006 and 2011.  With the developments in the pipeline, this pattern will continue.

Non-residential space translates to jobs, and this puts great pressure on the transportation network.  Some of these jobs will be taken by people who will walk, cycle or take surface transit to work, but many commuters will come from further afield via the subway and GO Transit.  The idea that downtown “has enough subways”, to quote Mayor Ford, would be dubious with the existing level of demand, but seen in the context of future development the statement shows foolhardy disregard for investment in city infrastructure.

There will be growth in the suburbs, but not at the scale of the core area.  Moreover, it is unclear that simply designating an area for growth will actually produce the desired effect without considerable incentives.  Motions by Cllrs. Vaughan and Nunziata approved by the Committee speak to opposite sides of the same issue:

The Planning and Growth Management Committee:

1. Directed the Chief Planner and Executive Director, City Planning to report on how to create a policy framework to cap growth in areas of hyper intensification and re-direct development in a strategic way to other parts of the city.

2. Requested the Chief Planner and Executive Director, City Planning in consultation with the General Manager of Economic Development and Culture, to report back to the Planning and Growth Management Committee on the methods the City of Toronto could employ to stimulate economic development in areas currently underused or vacant.

In the case of downtown, there are areas where developments, many proposed at substantially above the zoned density for the land, are skewing the property market and straining services for current and future residents.  In other parts of the city, notably Weston which is among the lowest income areas in Canada, there is plenty of land to develop, but no activity.  How much power does the City actually have (or wish to exercise) in shaping its future growth?

Major transit lines are planned or under construction, but it will be a decade before we see their effect.  Meanwhile, large areas now served by subway lines see little development.  How much of this is nimby-ism throttling growth and how much is simply market forces building where there is both a market and a profit?

The disconnect between actual and proposed development, and the goals and dreams of the City Councillors and their neighbourhoods is quite striking.  Without significant intervention by Council, a move that would be ideologically distasteful to many and certainly would be subject to legal challenges, controlling development, especially that which can occur “as of right”, will be very difficult.  Should the transit system be built to serve what is there today and what we know will develop, or will Council persist in planning based on dreams that do not match market realities?

The Transit Investment Panel: Hard Truths

After Metrolinx produced its report on revenue sources that might fund their regional plan, The Big Move, the whole thing was turned over to a newly created panel by Queen’s Park to review the options.

This panel now has its own website, and has issued the first of three discussion papers on the “Hard Truths” about transit in the GTHA.

One of the most damning statements about the depths to which Toronto has fallen appears in the Introduction:

Toronto used to be considered a transit system leader and all levels of government made bold investments to earn that reputation. We are reaping the benefits of those investments to this day, as a city, region, province, and country.

The Toronto region now ranks as the worst performer in Canada in moving people to and from work and is near the bottom of global rankings.

That’s what happens to a city that rests on a decades-old reputation for its transit network.  Toronto was spared some of the worst effects of hollowed-out downtowns thanks to postwar immigration and a robust local economy, but this masked deeper problems with the lack of investment in mobility around the city and region.  The central city, the one in all the tourist posters, prospered while gradually the suburbs strangled in traffic.

Debates about transit plans and funding are mired in misconceptions about what can and should be done, and the Hard Truths paper is intended to reset the discussion.  Whether the panel will be successful in their aim given the highly polarized political context remains to be seen.

These are hard truths, but until we accept them, we will not be able to have a mature discussion. Decisions will not be based on reason and evidence, but will be one-off decisions aimed at short term political gain.

The six truths are:

  • Subways are not the only good form of transit.
  • Transit does not automatically drive development.
  • The cost of building transit is not the main expense.
  • Transit riders are not the only beneficiaries of new infrastructure.
  • Transit expansion in the region is not at a standstill.
  • We can’t pay for the region-wide transit we need by cutting waste in government alone.

Continue reading

Moving People Downtown: The Gardiner East Is Only The Beginning

On October 16, 2013, the second public meeting in the Gardiner East Environmental Assessment presented additional information and refinement of the options for dealing with the expressway’s segment between the Don River and Jarvis Street.

The purpose of the meeting was to report on the options that would receive further analysis in the next step of the EA and to provide comparative information about costs and benefits of the various schemes.  Broadly, there are four families of options:

  • Maintain the existing expressway with necessary repairs to make it sound for several decades’ more service.
  • Replace the expressway on a new structure either above or below ground.
  • Improve the existing expressway by selective reconstruction to open up space under the road deck.
  • Remove the expressway and create an at-grade boulevard.

Some options have been dropped from further study:

  • An underground alignment 1km long transitioning to/from existing elevated structured at the Don and at Jarvis.
  • An elevated alignment over the rail corridor.
  • A surface alignment on a berm abutting the south side of the rail corridor.

For any tunnel option, an important consideration is that most of the traffic arriving from the DVP and Lake Shore East is bound for the core area rather than as through trips to the western side of Toronto and beyond.  Therefore, access ramps are essential to any option that is not at grade so that traffic can actually get to downtown.  (By contrast, the “Big Dig” in Boston provided a link between the north and south sides of the core area on a route where 80% of the travel is through traffic and does not create demand for local ramp structures.)

The study claims that 80% of inbound trips have downtown destinations and this argues against a tunnel from which access would be difficult.  However, consider the origin-destination charts on page 15 of the presentation:

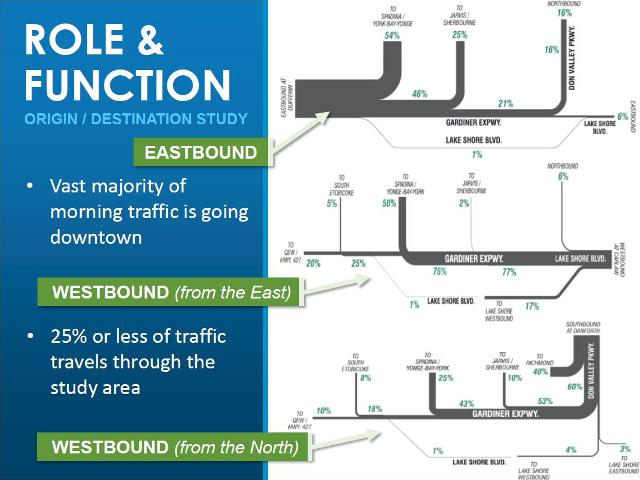

GE2P15

Of the traffic arriving from the DVP:

  • 40% leaves at Richmond Street
  • 7% exits to Lake Shore
  • 53% continues onto the Gardiner East, subdivided as
    • 10% exits at Jarvis/Sherbourne
    • 25% exits at Spadina/York/Bay
    • 18% travels beyond downtown.

If we were contemplating a tunnel across all of downtown, the argument about ramps and O-D patterns would be valid, but in this case, from the point of view of such a tunnel, most traffic is “through” traffic.  Only 10% of traffic that would enter a tunnel westbound at the Don leaves at Jarvis, and even this would be served if an off-ramp were incorporated in the transition from tunnel to elevated.  Similar arguments apply to the other O-D maps above.

The real problems with a tunnel are its cost and the barrier effect created by ramps linking the tunnel to the elevated structures at the Don and at Jarvis Street.

The schemes involving the rail corridor have both been dropped because they cannot be fitted into the space available.  In the case of an elevated, there is no room for the support structures needed (not to mention access ramps), and in the case of the berm, the area is reserved for future expansion of rail operations.

A far more important issue hinted at by the presentation but not explored in detail is the wider context of transportation into the core area.

Continue reading

Once Upon a Time in Scarborough

Mike Filey passed along to me a clipping from the Toronto Star of June 29, 1977.

A high-speed streetcar line providing service between the Scarborough Town Centre and the Bloor-Danforth subway has been approved by Metro Council.

The $108.7-million line … was approved on a 23-8 vote.

Streetcars on a separate right-of-way should make the trip in about 15 minutes.

The cost of this route was to be shared 75-25 between Queen’s Park and Toronto.

It is no secret that this line was not built, nor was the planned extension to what is now Malvern Centre.  Instead, Queen’s Park, always happy to meddle in Toronto’s transit planning, strong-armed Toronto and the TTC into changing to the technology we now have on the RT at a cost, by the time the line was finished, of about $240m.  The hope for low-cost transit expansion was dashed by a technology that was almost as expensive as a subway.

The network that might have sprung from this to serve Scarborough and other suburbs never materialized.  Instead, we have endured 36 years of arguments about where we can afford to put our next subway lines, one at a time.

Premier Bill Davis may have said that the city is for people, not for cars, but he did bugger all to advance that position by making Toronto a showcase for a failed transit technology rather than a burgeoning network that grew along with and shaped its suburbs.

Scarborough LRT Study, April 1977, Excerpts

TTC Service Changes Effective November 24 and December 22, 2013

Most of the service changes in November and December relate to construction projects that will wind down this fall.

Effective November 24, 2013

Bathurst Street Toronto Water work

The 511 Bathurst service will return to streetcar operation.  A special schedule for 512 St. Clair that kept mid-day service at peak levels (because the extra cars could not return to Roncesvalles Carhouse) will be replaced with the normal schedule.

Sterling/Dundas track and overhead work

The scheduled short turn of 505 Dundas, 506 Carlton and 306 Carlton Night services at Lansdowne will end and all service will run through to the usual destinations for these routes.

Dufferin Street paving

29 Dufferin will resume its normal route between College and Queen with the completion of paving north of Queen.

Dufferin Bridge

The Dufferin bridge at the CNE remains closed and all operations to Princes’ Gates have been dropped from the schedules.  This reduces the number of vehicles in service during certain periods.

Metrolinx construction

Service relief buses will be provided on 32 Eglinton West to compensate for construction delays with the LRT project.  A revised schedule will be implemented in January 2014.

Additional running time will be added on 59 Maple Leaf to compensate for work on the GO Transit grade separation in Weston.

Since August 19, 2013, 63 Ossington has looped at Eglinton Avenue rather than Eglinton West Station to avoid construction work.  This is expected to last until late November.

Lawrence West Station construction

Construction at Lawrence West Station required buses on many routes to be extended to Lawrence Station.  The following routes will now revert to their normal eastern terminus:   52C Lawrence West/Culford, 58 Malton, 59 Maple Leaf.  The 400 Lawrence Manor community bus will resume serving Lawrence West Station at the west end of its route.

Ossington Avenue trackwork

Service on 63 Ossington and 316 Ossington Night Bus will revert to Ossington Avenue between College and Dundas with the completion of the track replacement project.  Additional running time added for the diversion will be removed, but service improvements from August and September 2013 schedules will remain.

Updated:  Through service on Ossington resumed on October 28.

Queensway overhead work

In October, services on 501 Queen, 508 Lake Shore and 301 Queen Night Car were cut back to Humber Loop for streetcar island reconstruction on Lake Shore.  Starting in late November, the TTC will rebuild the overhead on The Queensway and these services will turn back from Sunnyside Loop.

The 301/501 Queen Shuttle bus will be extended east from Humber Loop via The Queensway and King to Dufferin Loop.  Service will operate every 6 minutes during peak periods, and every 6-10 minutes at other times (except for 30 minute night service).

The work is not expected to require the entire schedule period, and streetcar service will return to Humber Loop when possible.

Seasonal Changes

The Sunday/Holiday service to the Brick Works via 28A Davisville should have ended at the start of September, but this was missed in schedule changes at that time.  Saturday service is not affected.

Service to Canada’s Wonderland ends on Sunday October 27 after which buses on 165 Weston Road North will turn back at Major Mackenzie Drive.  The change will be formally in the schedule as of November 24.

Standby buses and streetcars will be provided across the system to handle demand due to Christmas shopping as needed.

Effective December 22, 2013

Kingston Road construction

Streetcar service on routes 502 Downtowner and 503 Kingston Road will resume to Bingham Loop.  The weekday extension of 22A Coxwell to Bingham will be dropped, and 22 Coxwell will operate as normal between Danforth and Queen.

Additional service on 12 Kingston Road, 64 Main, 69 Warden South, 92 Woodbine South that was provided during construction will be removed.

Lake Shore construction

Streetcar service on 501 Queen, 508 Lake Shore and 301 Queen Night Car will resume to Long Branch Loop.

Warden Avenue construction in York Region

68 Warden will revert, mostly, to the May 2013 schedules as provision for road work by York Region is no longer required.  Saturday late evening headways improved to 16’15” in September 2013, and this change will remain in place.

Christmas and New Year

For the two weeks of the holiday period, summer schedules will operate on weekdays except where these are holidays.  No school trips will be scheduled, but extra service using standby vehicles will be provided on many days.

The late night closing times for the Yonge Subway vary depending on the nature of each day.

Because of New Year celebrations downtown, the 501 Queen car will divert via Church, King and Spadina after 11:00 pm on December 31.  Extra service will be provided on 509 Harbourfront and 510 Spadina.

Service to the Zoo will be extended until 10:00 pm.

2013.12_Holiday_Summary
