Information on large transit projects and their status is scattered through several reports. Two of these appear on the TTC Board’s April 16, 2025 agenda, but for a broader picture we must look elsewhere. In part this is due to the split responsibility between TTC and the City’s Transit Expansion Office. Also, some details lie in the TTC Capital Budget, 10-year and 15-year plans.
On the April 16 agenda:
- Transit Network Expansion Update
- Financial and Major Projects Update for the Year Ended December 31, 2024
- Extreme Precipitation Planning
Previous City and TTC Reports:
- TTC 2025 Operating and Capital Budgets
- Advancing Waterfront East Light Rail Transit
- Advancing Eglinton East Light Rail Transit
- Sheppard Subway Extension Update
The TTC Capital Budget contains a high level listing of many projects much longer than in the “Major Projects Update”.
There is no surprise that the TTC faces a very large gap between its capital needs and available funding. The City is the primary funder for projects still on the TTC’s books, with smaller contributions from the provincial and federal governments. Expansion projects such as the Ontario Line were taken over completely by the province.
This greatly increases Ontario’s share of transit spending overall, but with the caveat that they build what suits their political climate, and Toronto is left to raise money, such as it can, for anything else. Another recent issue is that originally, Ontario’s projects were to be 100% capital with operating costs borne by the City. This has proved impractical, and Ontario now guarantees an operating subsidy for new Lines 5 and 6, albeit not in perpetuity.
As for the Federal government, it will (assuming the current government remains in power) fund a national transit program over ten years, but the money allocated to Toronto (and every other city) falls well short of their needs. Moreover, the funding is still done on a project basis with cities applying for each project rather than simply getting a block grant. This is different from the provincial and federal gas tax rebates to cities which can spend them as they see fit.
The TTC and City both produce reports tracking major transit projects, but these do not cover the full extent of the funding problem. Many issues with infrastructure condition, for example, are not mentioned in these reports although they are critical to the viability of transit service. In this article, I will review both the formally acknowledged “major projects” as well as the large dollar line items within the Capital Budget that get much less attention.
The TTC Major Projects
The TTC’s list is divided into four parts to segregate items for specific parts of the system.
- Easier Access
- Second Exits
- Fire Ventillation
- New Subway Trains
- New Signal Systems
- Capacity Enhancement
- Bloor-Yonge Project
- Station Transformation
- Purchase of Streetcars
- Hillcrest Facility
- Russell Carhouse
- SRT Busway Conversion
- Wheel-Trans Transformation
- Purchase of WT Buses
- Purchase of Hybrid and eBuses
- eBus Charging Systems
- Vehicle Location and Dispatch
- SAP Enterprise Management
- PRESTO

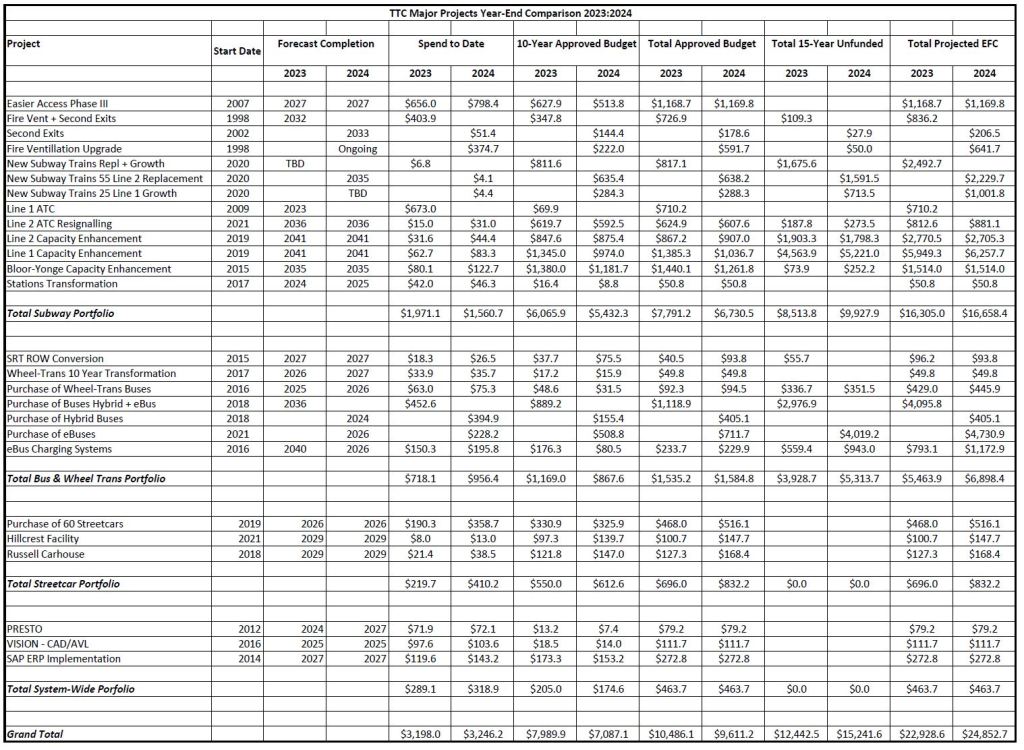

Comparing the year-end 2023 and 2024 financial information shows that some of these projects have increased considerably in value. These are examples of creep in project costs that can crowd out other needed work.
- New subway trains listed at $2.5 billion in 2023 have risen to $3.3 billion. In order to stay with the original funding request, the 55 trains for Line 2 were split off and 25 growth trains are now a separate line. The 55 trains show as 2/3 unfunded in 2024 because at year-end the federal and provincial contributions were not yet committed. The 25 growth trains still seek funding.
- The estimate for Line 2 ATC signalling rose from $812.6 to $881.1 million, and this is without any provision for the Scarborough extension.
- The total cost for bus purchases rose from $4.1 billion to $5.1 billion, most of which is for eBuses. This is an ongoing project that will replace about 180 buses annually, assuming funding can be found. This rate of purchases only allows for modest service growth.
- The cost of eBus charging systems rose from $793 million to $1.173 billion.
These “major projects” account for almost $25 billion in the capital plans, but they are not all.

The items below are listed in the major projects section of the Capital Budget and Plan, but are not tracked in the quarterly report, nor have they received the same attention when pols cry about the poverty of transit funding. Their total value is $3.4 billion. Although there was one major addition in the 2025 budget (a new control centre), over half of the change between the 2024 and 2025 budgets comes from increases in ongoing capital maintenance costs.
The TTC has not published detailed background information on its Capital Budget since 2019, and so there is no way to determine from available information how much of the change is due to scope creep versus basic cost growth.
| Project | Period | 2024-33 ($000) | 2025-34 ($000) |
|---|---|---|---|
| Major Control Centre | 2025-2027, 2030-2034 | 482,398 | |
| Bus Rebuild/Overhaul | Ongoing | 536,508 | 745,090 |
| TR (Line 1 & 4 Trains) SOGR | Ongoing | 233,545 | 390,359 |
| T1 (Line 2 Trains) SOGR | 2025-2032 | 222,555 | 217,508 |
| LRV Overhaul | 2025-2029 | 49,973 | 146,023 |
| Streetcar – Midlife Overhaul | 2025-2029 | 612 | 19,396 |
| Subway Track Rehabilitation | Ongoing | 276,655 | 298,195 |
| Streetcar Track Rehabilitation | Ongoing | 383,117 | 448,340 |
| Structure Rehabilitation | Ongoing | 205,064 | 207,302 |
| Roofing Rehabilitation | Ongoing | 99,096 | 124,226 |
| On-Grade Paving | Ongoing | 125,682 | 129,403 |
| Elevator Overhaul | Ongoing | 54,451 | 78,488 |
| Escalator Replacement | Ongoing | 44,166 | 49,597 |
| Station Finish Renewal | 2025-2028 | 40,243 | 28,813 |
| TR/T1 Rail Yard Accommodation | 2024-2030 | 114,642 | 99,528 |
| Total | 2,386,309 | 3,463,657 |
The numbers here are for the capital budget, and they do not reflect funding or staffing decisions for the day-to-day operating budget which includes a lot of routine inspection and repair.
The effect of deferred maintenance was clear for all to see in recent subway problems (slow orders) and the catastrophic end of the SRT, but this extends further. Another report on the April 16 agenda speaks of the effects of climate change and flags problems with maintenance of tunnels, drainage and other aspects of the system that collectively represent a large unfunded backlog.
The total value of these projects $1.4 billion, of which only $360 million is funded. Note that some of these items are contained within projects in the table above.
| Project | Funded 10-Year Total | Unfunded 10-Year Total | Unfunded Post-2034 | Total Cost |
|---|---|---|---|---|
| Roofing Rehabilitation Program | 124,226 | 211,448 | 113,678 | 449,352 |
| Storm & Sanitary Subway Pump Replacement Program | 66,803 | 315,000 | 67,092 | 448,895 |
| Replacement of Overhead Doors | 3,621 | 59,754 | 9,456 | 72,831 |
| Emergency Backup Power Systems | 1,600 | 1,600 | ||
| Building Facility Renewal Program | 12,874 | 4,943 | 7,182 | 24,999 |
| Subway Facility Renewal Program | 15,462 | 132,534 | 15,160 | 163,156 |
| Bus Garage/Shop Facility Renewal Program | 7,679 | 16,159 | 8,775 | 32,613 |
| On-Grade Paving Rehabilitation Program | 129,403 | 15,393 | 84,463 | 229,259 |
| Total | 360,068 | 756,831 | 305,806 | 1,422,705 |
The problem of funding TTC Capital Budgets was once seen primarily as affecting plans for system growth, but now threatens the ongoing maintenance and viability of the system. Far too much time and attention go to “my new subway” wherever that might be and not enough to the existing system.
Without question Toronto underspent on network growth for decades, but also lived on the initial capital value of new infrastructure. Much of the system is no longer “new” and that brings costs that cannot be avoided. Financial plans at all levels do not account for the huge backlog in unfunded costs, nor of the potential effects of system decay.
