Nineteen

Yes, dear readers, this blog’s anniversary rolls around again and with it, a chance to contemplate the past year in Toronto’s transit.

First, a thanks to my readers. We do not always agree, but the blog stats tell me that you keep showing up. The count of articles will clock over the 3,000 mark soon, but your comments (at least the ones I have approved) are pushing 61,000.

Readers have likely noticed that articles here are getting longer, with more detail about TTC operations, service quality and finances. I hope to inform politicians, the media, transit advocates and riders in more detail than TTC management typically provides. Policy decisions can be skewed by misinformed advice.

The TTC’s financial situation is tenuous, both for day-to-day operating funds and large-scale capital projects, notably the “state of good repair” work that prevents collapse of service from an overwhelming backlog of deferred maintenance. The City of Toronto provides more than its share of operating and capital support, and this is key in the context of ridership still below the pre-pandemic level, frozen fares and rising costs. Ambitious City plans to build ridership and to completely electrify the system will not be cheap, and we have not yet had an informed debate on what this will entail.

Provincial transit support comes mainly in large-scale rapid transit projects and expansion of regional service. Opening dates for Lines 5 Eglinton and 6 Finch remain a mystery, and other projects will not carry riders until 2030 or beyond. How much these will contribute to ridership growth and shift travellers from cars to transit remains to be seen. Just building tracks and tunnels does not build transit without better service on the network overall. That sits firmly with the City which claims to want more transit ridership.

Federal support is spotty and was historically linked to specific projects. There is now a 10-year transit fund set to dole out capital from 2026 onward, but with no guarantee of actual spending surviving a potential change in government. Much of Toronto’s allocation will go to new Line 2 subway trains if only a binding contract is actually signed. The scale of proposed capital spending greatly exceeds the announced funding, and uncertainty at the federal level compromises provincial contributions linked to federal participation.

Operating funding is a challenge not just at the simple level of who pays how much, but from basic, unanswered questions about an “appropriate” level of subsidy versus fares, and the effect of a large-scale change in the amount of transit service. After years of special covid subsidies, fare freezes and lower ridership, TTC’s farebox cost recovery sits at about 42%, down from about 60% pre-pandemic. (The typically cited number is 66% or two-thirds, but roughly 6% came from ancillary revenues such as parking lot fees, advertising and subway kiosk rentals.) If Toronto opts to run substantially more service than today, who should pay for that growth?

Funding at all levels could be threatened by economic upheavals thanks to misguided, vindictive protectionism from the USA. Will Toronto face even more limits on transit spending, and how should we as a City react to them?

From time to time I am asked whether I would stand for appointment to the TTC Board, and more recently if I would consider working for them. I now even have quasi-official recognition from CUTA for my long transit advocacy complete with a lovely glass plaque. But such a move would mark the end of this site and my ability to openly discuss transit issues. I already wear two hats in some cases. One day I might sit as a stakeholder on consultations, or have an off-the-record conversation. On another I might be a very public journalist/advocate. Keeping those worlds separate is an important part of credibility and trust.

Last year, I wrote about the blog’s early history and key issues facing transit in Toronto. Little has changed, but there are, dare I say it, early signs of a more activist, engaged Board. I have guarded hopes for the TTC with a pro-transit Mayor and supportive Council, the removal of the former CEO, and a shift among Board members to better understand the policy options available for improving transit.

A crucial choice faces the City and TTC in picking a new CEO for a combination of expertise, experience and transparency. Another member of the old boys’ club we do not need. Far too many staff were lost in recent years thanks to a combative work environment where personal loyalty counted for more than competence.

As we begin the twentieth year here, I hope to continue the debate and support those who will fight for better transit.

Swan rampant in Stratford

TTC Board Meeting Wrap-Up – January 27, 2025

This article covers:

  • The January 2025 CEO’s Report
  • A follow-up on the report re Subway Streetcar Fleet and Infrastructure
  • The proposed interim wayfinding strategy
  • An update on fare collection technology
  • A new procedure for handling complaints about CEO misconduct

I will cover the 2025 Annual Service Plan and the Corporate Plan Update in a separate article.

Location of Reports Changed

Effective with this meeting, the agendas and reports for Board meetings have shifted to the City’s meeting management site which hosts Council and Committee meetings. This will also host documents for Board committees such as Audit & Risk Management. Information for past meetings continues to be available on the TTC’s own site.

In Fall 2024, the CEO’s Report was reorganized with the Key Performance Indicators split off from the main report. There are now separate pages on the TTC site for accessing monthly CEO’s Reports and KPI reports.

Continue reading

TTC Historic Fleet Moves to Streetcar Museum

Updated January 29, 2025 at 7:35am: I have just received a note from the TTC stating that the historic fleet will return to Toronto following completion of reconstruction at Hillcrest. Good news, eventually.

From time to time, readers ask when or if the TTC will retrofit its historic streetcar fleet with pantographs so that cars can operate on the new pan-only overhead. That question is now answered with the move of these cars to the streetcar museum at Rockwood, the Halton County Radial Railway.

Peter Witt 2766 and PCC 4500 are already at the museum as of January 28. 4549 will move on January 29, and the CLRVs will move on February 3 & 4.

Here is car 4549 sitting at Hillcrest ready to leave.

Photo by an anonymous reader
Continue reading

Delving Into TTC “On Time” Performance

The TTC produces a monthly summary of On Time Performance for its bus and streetcar networks. To call it superficial would be generous, but there are pretty charts.

First and most obvious among the problems is that the TTC never hits their target which is 90% across the system. Streetcars fare worse than buses because proportionately more of that network is affected by construction and diversions.

“On time” is defined as leaving a terminal within a six minute window from 1 minute early to 5 minutes late. In practice, for routes with frequent service, this means that vehicles can run in pairs but be counted as “on time”. A related problem affects branching routes where there is no management nor measurement of the regularity of services merging together on an even spacing.

There is no standard nor measurement of schedule adherence anywhere else on the route. Most riders do not board at terminals, and so service quality is not measured where most riders see it.

The second problem is that the reported numbers aggregate an entire month’s data for every route. There is no indication of problem routes or time periods, or of how this relates to periods when many riders are trying to use the service.

In an attempt to learn the details beyond the summary numbers, TTCRiders recently made a Freedom of Information Request for route and time period “on time” data from September 1 to November 16, 2024.

The charts in this article review the TTC data at increasing levels of detail to show how different that view is from the simplistic summary values published as “key performance indicators” in the CEO’s Report.

First, here is a breakdown by mode. The roughly echoes the values reported by the TTC with bus service achieving just over 80% “on time” trips and streetcars about 70%. Broken out here are the Express Bus routes (900 series) and the Blue Night routes (300 series). Note that night services which should have no problems with traffic congestion do not fare well.

When the status for each mode is subdivided by time of day, things are not quite as rosy. In the charts below, there are four sets of columns corresponding to weekdays, Saturdays, Sundays and Holidays. Within these are six time periods.

  • Weekdays: AM Peak, Midday, PM Peak, Early Evening, Late Evening, Overnight
  • Others: Early Morning, Late Morning, Afternoon, Early Evening, Late Evening, Overnight

Note that “on time” performance for streetcars (green) falls in the evenings and especially on weekends. Nowhere in the official KPIs does the TTC admit to only hitting 50% “on time” on part of its network.

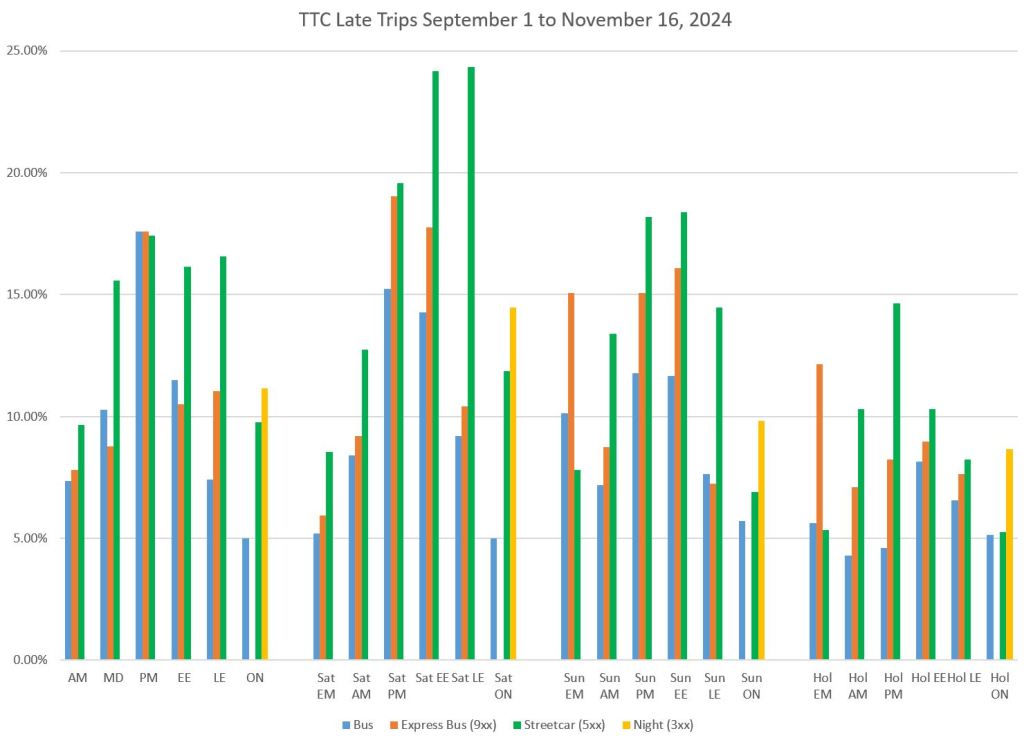

The upper right chart shows the proportion of late trips (more than 5 minutes after a scheduled departure). The percentages are high in the PM peak and evenings, with Saturday being particularly bad.

The lower left chart shows the proportion of early trips (more than 59 seconds before a scheduled departure). Streetcars run early at terminals much more than buses. This might be related to the idea of getting a “head start” on a trip where delays are anticipated on busy downtown routes.

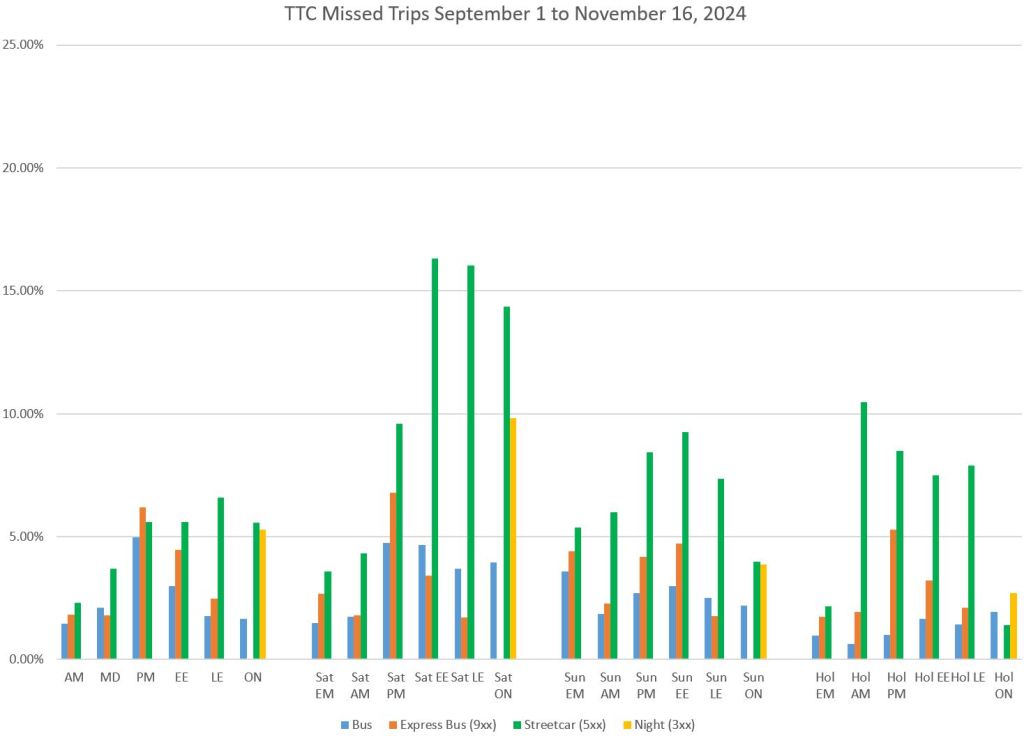

The lower right chart shows missed trips. These are defined as trips that are over 20 minutes late or just do not show up at the terminal. This can occur due to short turns, operator or vehicle shortages, or severe schedule disruption. Note that on Saturday evenings about 1/6 of the streetcar service never reaches its terminus.

The yellow bars (night service) only appear on the rightmost of the six columns because that is when 300-series routes are in service. About 20% of the service is late or early, and on Saturdays [actually Sunday morning] about 10% of service is missing at terminals. Reliability is quite poor on a service riders depend on for safe travel to and from shift work.

In the following section, charts provide a route-by-route view of performance. They illustrate the wide variation by route and time period that is completely lost in overall averages. Many routes achieve 90% “on time” status much of the time and these pull up the system averages. However, some routes perform quite poorly. This problem did not just develop in the past few months. Consolidated reporting masks the problem routes and times, and hence the need for management to address service reliability.

Continue reading

TTC 2025 Subway and Streetcar Infrastructure Projects

The agenda for the January 27 TTC Board meeting contains two reports containing information about infrastructure work planned on the rail networks in 2025.

The Service Plan details proposed route changes for 2025 and evaluations of some options that were not recommended. I will address this part of the report in a separate article.

The State of Good Repair report addresses the current situation with needed infrastructure maintenance, and contains a detailed calendar of planned work including major projects requiring streetcar diversions. The Service Plan includes some of the proposed route configurations.

Subway Plans

The subway plans are extensive and will see more partial or total service suspensions than in past years. This comes in part from the fact the subway is aging, but also from a recognition that past years have not seen the level of maintenance required to keep the system in good shape. One key item arising from recent major disruptions is the state of the work car fleet. Many specialized vehicles are used for aspects of subway maintenance, and their reliability and availability have not been at the level the TTC needs.

Work planned during subway closures are reliant on work cars to aide in the performance of the scheduled activities. As such, the TTC’s 2025 Operating Budget includes $0.8M to bolster work car maintenance and the 2025-2034 Capital Budget and Plan includes $35.6 million of approved funding for work car overhauls as well as $62.9 million toward work car procurements. These investments, as approved by the TTC Board on January 10, 2025, and before City Council for consideration on February 11, 2025, are required to increase reliability and respond to increased demand for work cars due to higher capital activity. [p. 2 SOGR report]

In a section reflecting on the growing amount of maintenance work, the report observes:

[…] significant investment into these programs is required along with the procurement of suitable work cars through a phased fleet replacement approach and rolling stock transition plan. To ensure the TTC is able to continue delivering on its state-of-good-repair program, while accommodating future growth and expansion projects, the availability of work cars for trackside activities and the time required to maintain the work cars in a state of good repair is inversely proportional, and as such, it is critical that the capacity to provide safe, reliable and available work cars is built into future plans. [p 12 SOGR report]

Many problems with the work car fleet originated with deferral of a renewal and expansion plan proposed in Andy Byford’s era as CEO, but sidelined under Rick Leary.

Closures are expensive because of many factors. These costs are recovered through the capital project budgets and from external parties, notably Metrolinx. They are not part of the regular operating budget.

Subway closure costs are variable and dependent upon the duration and distance of the closure territory, along with the complexity of the work. The cost for each closure is attributed to the incremental costs for buses, advertising, and staffing. This includes Operators, contracted customer service support staff, TTC staff to supervise the closure, paid duty police officers, and parking enforcement officers. The average subway early closure cost is approximately $35,000 per evening and the average full, two-day weekend closure cost is $500,000 per weekend ($250,000 per day). [p. 1 SOGR report]

The detailed list of proposed 2025 closures is organized by date and this shows how some work has been scheduled so that two or three projects can take advantage of one shutdown at a time [pp 17-30 SOGR report]. However, this makes major projects that spread over many weeks more difficult to see along with the dates when specific parts of the network will be closed. The main part of this article includes charts showing the dates and locations of closures.

An important issue raised by the report is the TTC’s ability to perform all required maintenance work in the time available.

On the subway side, a significant increase in production time is required to continue to maintain its assets in a state of good repair. Given the current rate of track asset deterioration, it is expected that the average production time of approximately 92 minutes will need to approximately double to more than 180 minutes to continue to ensure all assets remain in a safe and reliable state. [p 11 SOGR report]

That “92 minutes” refers to the productive work interval between shutdown and startup of subway service, and has been cited recently by management when discussing the Reduced Speed Zones list. That connection is misleading in that major track rehabilitation is done during longer “possessions” of subway lines either through early closing, or weekend shutdowns. Indeed, TTC management have often touted how one weekend’s work is equivalent to many short weekday sessions.

The TTC contemplates options for extending the time to perform maintenance:

  1. Organizing full weekend closures with significantly larger closures boundaries (i.e. Kennedy to Broadview closure).
  2. Weekly early access closures commencing at 10 p.m. with larger boundaries.
  3. Nightly suspension of subway service at midnight across some or all subway lines, rather than 2 a.m.
  4. Various multi-day or multi-week closures of various points of the subway system. [p 12 SOGR report]

An important question here is how much of the SOGR list’s size is due to growth and aging of the network, and how much from deferred maintenance? Is the TTC in danger of becoming unmaintainable because the backlog is too long? Are more extensive shutdowns a “new normal”, or can we hope for a time when the project list is shorter?

Closing the subway earlier will have major effects on riders. Toronto is not a city where transit riding evaporates at 7pm. The transit network is vital both for entertainment activities and for the many workers who do not have 9-to-5 commutes. Indeed, the TTC routinely cites the importance of evening and night service for both economic and safety reasons.

Streetcar Plans

The report acknowledges that streetcar infrastructure is falling out of good repair:

Given the City’s challenges, certain TTC work has been deferred over the past several years. As the assets continue to age and are subjected to the daily service demands, a long-term execution strategy, post-2026, is required. This situation is further compounded by the ongoing Gardiner Expressway construction work and the Ontario Line expansion that limits TTC’s ability to replace its deteriorating assets on parallel routes (i.e. King, Queen, and Dundas). In the coming years, the prognosis is that TTC will need to expand its current state-of-good-repair work to meet the growing service demands at the forecasted asset deterioration rate. [p 12 SOGR report]

Again, the question is whether the system can sustain an increased level of SOGR work without having many major routes out of service simultaneously. The main part of this article looks at the proposed work and the related diversions, where they are known.

One project that will end, eventually, is the reconstruction of the overhead power distribution system for full pantograph compatibility. Some of this work is co-ordinated with shutdowns for track, road and utility repairs, but some projects are scheduled on their own. Work is not necessarily undertaken when scheduled, and riders have suffered from service replacements and diversions while nothing appears to be happening.

Across both the subway and streetcar systems, Toronto now sees the effect of reduced maintenance and past year budgets that claimed to be adequate but concealed a slow decline. This has happened in other cities, but the TTC always fancied itself immune to such problems.

The report warns of changes needed in 2026 and beyond, but does not explore the details. The TTC Board and the riding public deserve a full airing of this situation together with a recovery plan.

Continue reading

You’re Not Crazy: TTC Service Is Worse

In the political hoopla surrounding the City budget, and the level of support transit will get, we regularly hear claims from the TTC that its service is close to 100% of the pre-pandemic level. Further improvements are planned for 2025.

This story is echoed by Mayor Chow as one of the “good news” pieces about our city.

There is only one small problem: it isn’t true.

The metric behind the claim is “service hours”. This translates directly to the number of operator hours in the service budget. Yes, other factors affect total costs, but operator hours relate fairly well to expenditures and provide a simple, single variable to track over time.

However, the rider experience comprises three very different factors: frequency, reliability and capacity. Infrequent service is not worth the wait, especially for short-hop trips. Service that shows up in bunches, if at all, following an interminable wait compounds the problem. Inadequate capacity tells riders that comfort is not important in spite of a customer first focus.

Over the years, a service hour has provided less real “service” to riders because buses and streetcars take more time to make the same round trip than they did in past years. This was acknowledged by a chart in the TTC’s 2025 budget presentation deck. Slower buses and streetcars arrive less frequently and provide less capacity.

Another metric, vehicle mileage, does not tell the whole story either. The average speed varies quite substantially from route to route, and the relationship between vehicle hours and kilometres is not the same across the system by route, time of day, or day of the week. Average values system wide can differ greatly from those for individual routes and time periods.

The charts in the main part of this article review service levels in January 2025 and January 2019, before the pandemic with data taken from the TTC’s own Scheduled Service Summaries (archived copies are available on this site).

All streetcar routes and the most heavily travelled bus routes are included. The streetcar comparisons also include January 2013 data from the period before new, larger vehicles were introduced.

There is no question that traffic congestion across the entire city is an issue, and this shows up in longer travel times scheduled for these routes. However, a larger component of the increase lies in terminal time that is provided not just for a bio-break for operators, but as padding to attempt better on time performance. (I will turn to OTP and how well the TTC achieves its own goals in a separate article coming soon.)

When Rick Leary was CEO, his stock approach to improved route performance was extra time in schedules, coupled with a “no short turns” edict. The result can be seen in clusters of buses and streetcars at terminals thanks to extra time they do not always require. We can argue about the appropriate amount of terminal time, but there is no question that this factor has grown more than the time actually provided for travel along the route. This translates to extra operator hours that only indirectly provide service to riders to the extent that they might provide less erratic service.

The combined effect of traffic conditions and added terminal time is that capacity actually provided on routes has declined and by a far greater percentage than “getting back to 97% of pre-pandemic service” implies.

On streetcar routes, lower capacity combines with larger, less frequent vehicles to produce wider gaps, and to make any irregularity much more pronounced. We have seen the effect of larger vehicles and longer headways before when the 15m CLRVs were replaced by 23m ALRVs on Queen. The wider headways (arising from a combination of vehicle size and slower operation) succeeded in driving away roughly 1/3 of the demand on 501 Queen at a time when other routes were holding their own. This is a major concern with new streetcars that arrive, even if on time, much less frequently than in the era of shorter cars.

By widening the scheduled gap between streetcars and buses (the “headway”), the TTC has avoided increasing its peak vehicle requirements and staffing.

If the capacity of streetcar routes in peak periods were restored to 2019 levels, the TTC would need 40 more cars in service. On the bus network, considering only the routes analysed here, they would require about 150 more buses. (This will be reduced by the opening of Lines 5 and 6 which will eliminate many buses on routes 32 Eglinton West, 34 Eglinton East and 36 Finch West.) This shows how riders are short-changed by a metric that only looks at vehicle hours, not at how vehicles are used and the capacity they provide.

These increases can be accommodated within the existing fleets. The problem is not vehicle availability, but the budgetary headroom to operate the service.

One can argue that ridership has not fully recovered on all routes, and a return to full capacity would waste resources. What we do not know is how many former and potential riders are lost to the decline in service quality especially when the TTC repeatedly claims it is close to 100% of former service.

Continue reading

TTC Fleet Utilization

From time to time, a discussion arises about the makeup of the TTC’s surface fleet, how it is utilized and the effect on service levels. This article presents details broken down by vehicle type to show variations across the system.

My apologies to readers if this seems a tad nerdish, but any discussion of future service requires an understanding of the fleet’s makeup and how it is used. Any fundamental differences between vehicle types will affect future planning, but equally there are inherent differences in types of routes and schedule designs that have nothing to do with the vehicles.

The charts in this article are based on tracking data accumulated by Darwin O’Connor at TransSee for the months of November and December 2024, less a few days around Christmas when the site was offline.

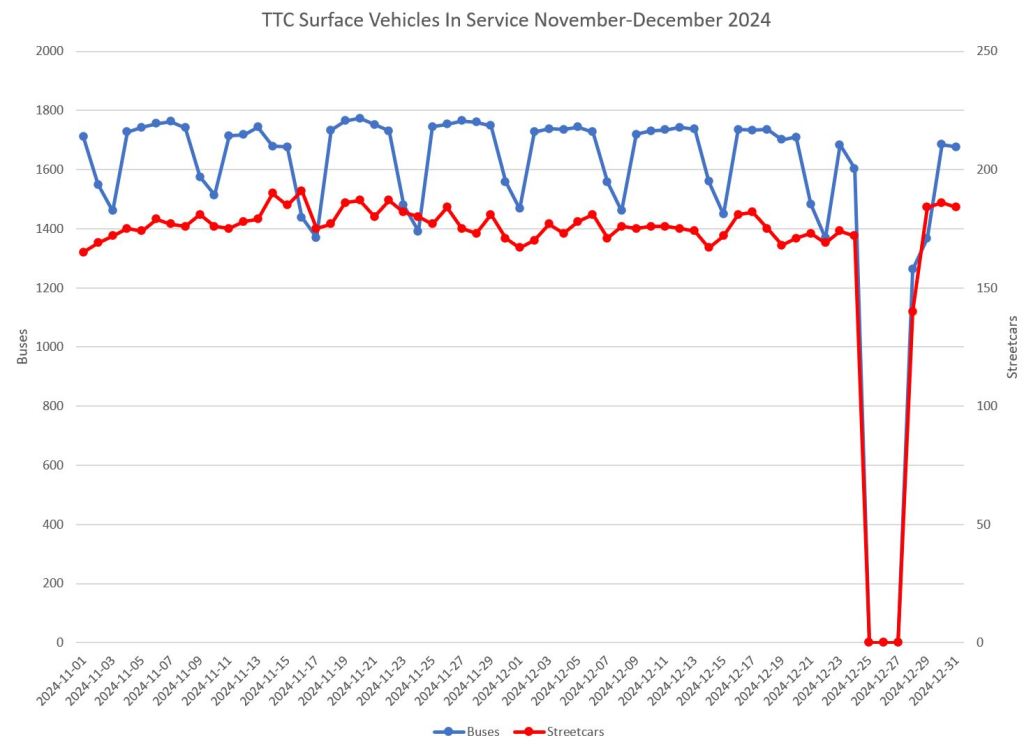

First, a basic question about how many vehicles were actually active over the two-month period. The chart below shows the daily count of vehicles that were observed in service by the TTC’s tracking system and TransSee during the period.

The peak number of buses (blue) is higher than the peak service requirement shown on the Scheduled Service Summaries for these months. The difference is due both to “Run as Directed” buses which do not show up in the assigned vehicle counts, and to buses that only work for part of the day and are replaced by other vehicles for various reasons.

The situation for streetcars (red) is similar, but with a smaller difference because there are few “RAD” streetcars and most cars stay in service all day, as shown in the detailed stats later in the article. Another important difference for streetcars is that weekend service is close to weekday service in terms of the number of vehicles used.

The bus fleet is in flux as old vehicles are retired and replaced by new deliveries. If anything, this should increase availability by removing the least reliable vehicles from service. The streetcar fleet is growing with deliveries of new cars that will continue through 2025. Service levels for both modes have yet to catch up with fleet size and availability, although some improvements are planned later this year.

The remainder of this article looks at the stats for individual vehicles, grouped by type.

Continue reading

TTC 2025 Budget Meeting Follow-Up

This article includes observations and updates from the January 10, 2025 TTC Board meeting. For background information on the Operating and Capital Budgets, please refer to my previous articles:

The budget report and presentation deck are available on the TTC’s site:

This was the first Board meeting for Deputy Mayor Ausma Malik and Councillor Alejandra Bravo as Commissioners. They replaced Councillors Chris Moise and Stephen Holyday.

There was relatively little debate on the details of the budget with the overall sense being relief that the TTC will be able to make some improvements in service in 2025. However, three Commissioners proposed amendments to the recommendations that foretell a more actively involved Board in setting policy in the coming year.

Normally the Board agendas are released at least a week before meetings in keeping with practice by the City Clerk for Council and Committee agendas. Although it appears, according to Commissioner Matlow, that the budget report was completed a few weeks ago, it was not released until a few days before the meeting when the Mayor and TTC Chair held a press conference to announce the high points. This may serve their post-holiday scheduling, but not the public’s (or other Board members’) ability to digest and comment on the budget in time for the Board meeting.

Motion by Commissioner Matlow

[The Board] Directs the TTC CEO and Director – Commission Services, to publicly release the TTC’s annual budget at least 10 business days prior to its consideration by the Commission.

For many years, the budget has arrived as a fait accompli at the Board with no room for debate about priorities or changes in underlying assumptions about the Board’s goals even when a new Board inherits the philosophy behind an outgoing Board’s budget. The Board has taken a very hands off approach leaving decisions to management with, as we have seen recently, less than ideal results as the priority for tight budgets compromised system integrity.

The motions below are intended to re-establish an active Board as the TTC and City look to establish a stronger role for transit, and to set priorities before budgets lock in past assumptions.

Motion by Commissioner Bravo

[The Board] Establish a Strategic Planning Committee to assist the TTC Board in managing strategic planning and priorities, including through a Ridership Growth Strategy and other existing strategic documents, and direct the Director, Commission Services to report back to the February 24, 2025 TTC Board meeting on a proposed structure and meeting schedule after canvassing Commissioners’ interest in committee membership.

Amend the 2025 Schedule of Meetings to add a Special Meeting of the Board in September 2025 to consider recommendations from the Strategic Planning Committee, receive an update on the 2026 Budget, and discuss budget priorities informing the development of the 2026 TTC Operating Budget; 2026-2035 Capital Budget and Plan and 15-Year Capital Investment Plan and Real Estate Investment Plan Update.

Direct the Director, Commission Services to include a Special Meeting to consider recommendations from the Strategic Planning Committee, receive an update on the next year’s budget, and discuss budget priorities informing the development of the next year’s budgets in future year’s recommended annual schedule of Board and Committee meetings for the Board’s approval, in accordance with Section 20 of the By-law to Govern Board Proceedings.

Chair Myers proposed overlapping goals based on the TTC’s Ridership Growth Strategy. The original RGS from 2003 operated from the premise that management should tell the Board what might be possible as a menu of costed options, rather than precluding discussion on the basis that “we can’t afford it”. The 2018 update was written in the context of rising demand and crowding, and included changes such as the two-hour transfer and GO Transit fare integration. Unsurprisingly, it flagged key factors for both existing and potential new riders: trip duration, wait time, crowding, affordability and reliability. Fare changes can only go so far, and service quality is inherent in four of these five.

The points about hiring strategy are important because past attempts to implement service improvements were hamstrung by “we have no staff”. Establishing priorities well before the budget is finalized can reduce lead times to expand service. (A related change in the 2025 Operating Budget speaks to the need for an improved recruitment process within the TTC.)

Motion by Chair Myers

TTC Staff conduct public consultations and develop a Ridership Growth Strategy 2.0, building upon the Ridership Growth Strategy 2018-2022 and report back to the Board in July 2025;

TTC staff develop a hiring strategy on the basis of the approved Ridership Growth Strategy 2.0 and report back to the Board by October 2025; and

TTC staff use the approved Ridership Growth Strategy 2.0 and associated hiring strategy to inform the 2026 TTC Budget process.

Continue reading

TTC 2025 Capital Budget and Plan – Preliminary Review

This is the second article in my review of the TTC’s 2025 budget package to be discussed by their Board on January 10, 2025. The Operating Budget is covered in the first part.

The Capital Budget and Plan exists in various forms:

  • A one-year budget for the current year.
  • A 10-year plan corresponding to the City’s financial planning horizon. In past years this tended to contain only approved projects for which funding was certain, but now some projects are only funded in early years.
  • A 15-year plan takes a longer view and includes many projects that have not reached the approval stage. The intent is to give the City and other funding partners a heads up on the longer term needs for transit funding.

Separately there is a Real Estate Investment Plan. This was created a few years ago in response to project delays caused by the time needed to acquire property before works could go ahead. In some cases, this gives early warning of items that have not even shown up in the 15-year plan. I will address the Real Estate Plan in the third article in this series.

When the 15-year plan was first unveiled, it shocked City financial staff, Council and the TTC Board with its scale then roughly three times the 10-year plan. Over the years projects would pop up from the TTC with little warning because they did not appear on official lists until they were approved. (Only a few enjoyed special status of “below the line” as placeholders in anticipation that someone would pay for them when the time came.) Now everything was on the table, but with no sense of priorities beyond broad areas such as “state of good repair”

The three budgets/plans have grown substantially over the years, as has the City’s expected share of the cost thanks to Provincial and Federal governments backing away from what once was an assumed one third contribution to whatever the TTC proposed. Today, funding from these governments is a mix of ad-hoc allocations to specific projects and some dedicated yearly funding, albeit nowhere near enough to cover what is proposed.

The charts below show the 1-year, 10-year and 15-year versions of the plan broadly subdivided by category and portfolio (groups of projects generally related to one part of the network such as the subway). Note that the 10-year plan is roughly ten times the cost of the 1-year budget, but the 15-year plan is over three time the 10-year plan. This implies a massive jump in spending, and it is hard to believe that scale of change will occur.

The 2025-2039 plan is up by $5.4 billion over the corresponding 2024-2038 plan, or 11.4%. The unfunded amount is almost the same ($37.0 billion in 2025 vs $35.5 in 2024) because of new money freed up by provincial assumption of major highways from the City.

The main additions are listed below (Budget report at p. 42):

  • An accelerated rate of SOGR for critical infrastructure such as subway pumps, escalators, elevators, and other aging assets (Subway/SOGR) – $0.9 billion
  • An accelerated rate of surface track replacement (Streetcar/SOGR) – $0.5 billion
  • Addition of Net Zero requirements for facilities (Facility/SI) – $1.5 billion
  • Vehicles and infrastructure required for TransformTO service enhancements for streetcars and refined estimate for bus service (TransformTO/Growth) – $1.1 billion
  • Procurement of additional subway cars to support future growth and service maturity (Subway/Growth) – $0.7 billion

There are large projects in the later years of the plan contributing to the high cost beyond year ten. Some of these are described as “aspirational” which is a polite way of saying they are unlikely to materialize. However, the political problem remains that the big number, $53 billion, gets the attention and would-be funders cough on the size. Prioritization is an obvious requirement, but that has political challenges.

Note that these budgets do not include the large provincial projects such as the Eglinton and Finch LRT lines; the Ontario, Scarborough and Yonge North subway lines; nor the GO Transit expansion including the SmartTrack stations Toronto will pay for. Those are in the Metrolinx budget, not TTC.

Continue reading

TTC 2025 Operating Budget – Preliminary Review

The TTC released its 2025 budget package on January 7 including the proposed Operating Budget, the Capital Budget and Plan, and the Real Estate Investment Plan. The TTC Board will discuss this package at its meeting on January 10.

This article is a preliminary review of the Operating Budget. I will turn to other parts of the package in separate articles, and will add follow-up articles after the Board meeting.

Highlights:

  • Fares continue to be frozen at 2023 levels.
  • The total Operating Budget for 2025 is $2.819 billion of which $1.387 billion will be covered by City subsidies. This is broken down as:
    • Conventional system: $2.636 billion with a subsidy of $1.214 billion
    • Wheel-Trans: $182.6 million with a subsidy of $173.2 million
  • Service hours will be increased by 5.8%. There are some specifics in the budget, but more details are to follow.
    • 1.7% increase to account for ridership growth and new services for accessibility pending completion of the Easier Access program.
    • 2.2% increase for off-peak service.
    • 1.9% increase for opening Lines 5 and 6 together with bus network changes (tentatively planned for July and August, respectively, subject to Metrolinx confirmation of dates).
  • Specific service improvements listed in the budget include:
    • Implementation of 6 minute service or better from 7am-7pm, 7 days/week on 505 Dundas, 511 Bathurst and 512 St. Clair.
    • Return to pre-pandemic wait times on subway lines during off-peak periods.
    • Restoration of pre-2023 off-peak crowding standards. Service will be increased starting in April on nine priority routes (not listed).
  • Increase in Wheel-Trans service to handle an expected 4 million more rides in 2025.
  • Increase in capacity to recruit, train and develop the workforce.
  • A pilot program on 10 key routes to reduce bunching and gapping.
  • A pilot program to improve cleanliness in six key subway stations (Scarborough Town Centre, Kennedy, Dundas, Finch, Spadina, Lansdowne).
  • Improved maintenance and asset management for key items such as subway work cars.
  • Beginning an environmental resiliency program.
  • Expanding the fare compliance program to increase revenue.
  • Cost savings of $37.2 million from budget reviews and efficiencies.

These items are discussed in more detail in the main part of the article. Many parts of the budget are presented here only in summary with tables showing financial breakdowns. Readers interested in further details should consult the TTC’s budget report linked above.

Continue reading
